Overview
The Rogun Dam is a major hydroelectric infrastructure project currently under construction on the Vakhsh River in southern Tajikistan. Designed as an embankment dam, the structure represents one of the most significant energy developments in Central Asia, aiming to harness the hydraulic potential of the Vakhsh River for power generation. The facility is situated approximately 110 km from Dushanbe, the capital city of Tajikistan, positioning it as a critical component of the nation's energy security strategy. As part of the broader Vakhsh Cascade of planned hydroelectric power plants, the Rogun Dam is intended to provide substantial baseload power to the region, leveraging the consistent water flow of the Vakhsh River.
The project is classified as under construction, reflecting the complex engineering and logistical challenges associated with building a large-scale embankment dam in a mountainous terrain. The planned installed capacity of the Rogun Dam is 3780 MW, making it one of the largest hydroelectric facilities in the region by output. This capacity is derived from the water source of the Vakhsh River, which feeds the turbine generators to produce electricity for domestic consumption and potential export. The operational status remains under construction, indicating that while significant progress has been made, the final commissioning and full integration into the national grid are ongoing processes.
The Rogun Dam plays a pivotal role in the Vakhsh Cascade, a series of hydroelectric plants designed to optimize energy production along the river's course. By integrating with other planned facilities in the cascade, the Rogun Dam contributes to a more stable and diversified energy mix for Tajikistan. The project's location on the Vakhsh River allows for efficient water management and power generation, supporting both local energy demands and regional energy interconnectivity. The embankment design is chosen to accommodate the specific geological and hydrological conditions of the site, ensuring structural integrity and long-term operational efficiency.
History of Construction and Delays
The concept of a major hydroelectric facility on the Vakhsh River has been debated for decades, with initial proposals emerging in 1959. These early plans envisioned a significant infrastructure project intended to harness the water resources of southern Tajikistan. The location, situated 110 km from Dushanbe, was selected for its strategic position within the planned Vakhsh Cascade of hydroelectric power plants. For nearly two decades, the project remained in the planning and feasibility stages, reflecting the complex geological and economic considerations required for a dam of this scale.
Soviet-Era Construction and Abandonment
Physical construction of the Roghun Dam officially began in 1976 under the Soviet Union. This phase marked the transition from theoretical planning to tangible infrastructure development. However, the project faced significant challenges related to funding, engineering complexity, and shifting political priorities. By 1993, the construction was effectively abandoned, leaving the site in a state of partial completion. This abandonment coincided with the dissolution of the Soviet Union and the subsequent economic turmoil in the newly independent Tajikistan. The hiatus lasted for several years, during which the dam's future remained uncertain due to financial constraints and technical reassessments.
Restart Attempts and International Involvement
In the years following the Soviet-era abandonment, various attempts were made to revive the project. These efforts involved complex negotiations with international partners, most notably Russia. The involvement of Russian entities, including the aluminum giant RUSAL, became a central element of the restart strategies. RUSAL's interest was driven by the need for reliable and cost-effective energy for its smelting operations in Tajikistan. However, these partnerships were fraught with disputes over pricing, ownership, and the technical specifications of the dam. The project's status remained "under construction" for extended periods, reflecting the intermittent nature of the work and the ongoing political and economic negotiations. The path to the 2018 commissioning date was marked by these prolonged delays and the necessity of securing substantial foreign investment and technical expertise. The dam's eventual progress is a testament to the persistent efforts to realize the hydroelectric potential of the Vakhsh River, despite the historical setbacks and international complexities involved.
Technical Specifications and Design Alternatives
The Rogun Dam is designed as a massive embankment structure on the Vakhsh River, forming a critical component of the Vakhsh Cascade hydroelectric system in southern Tajikistan. The project represents one of the most significant infrastructure undertakings in Central Asia, aiming to harness the river's flow for substantial power generation. The current design specifications outline a projected dam height of 335 meters, a figure that has evolved significantly from earlier construction phases and alternative engineering proposals.
Design Evolution and Height Alternatives
Historical construction efforts prior to the modern phase resulted in a much lower structure. Until 1993, the actual height of the dam stood at 60.96 meters. This initial phase provided early insights into the geology and hydrology of the site but fell short of the ultimate capacity goals. Subsequent engineering reviews considered several alternative height options to balance cost, geological stability, and energy output. These alternatives included a 300-meter configuration and a 265-meter configuration. The selection of the 335-meter height reflects a compromise between maximizing reservoir storage and managing the complex rock-fill construction requirements of the Vakhsh River valley.
Capacity and Energy Output
The technical specifications for the completed facility target a total installed capacity of 3600 MW. This figure is closely aligned with the broader project capacity of 3780 MW often cited in regional energy planning documents. The dam is designed to generate an annual output of 17.1 TWh, making it a cornerstone of Tajikistan's energy mix. The power plant utilizes the head provided by the embankment dam to drive turbines, converting the kinetic energy of the Vakhsh River into electricity for domestic consumption and potential export. The facility remains under construction, with the 2018 commissioning date marking a key milestone in the project's timeline, likely referring to the initial operational phase or a specific unit rather than the entire 335-meter structure.
| Parameter | Value |
|---|---|
| Project Capacity | 3780 MW |
| Planned Turbine Capacity | 3600 MW |
| Annual Output | 17.1 TWh |
| Projected Height | 335 m |
| Height (until 1993) | 60.96 m |
| Alternative Heights | 300 m, 265 m |
| Commissioning Milestone | 2018 |
Why it matters
The Rogun Dam represents a transformative infrastructure project for Tajikistan, designed to significantly enhance the nation's energy security and economic stability. As one of the highest projected dams globally, its construction on the Vakhsh River underscores the strategic importance of hydroelectric power in Central Asia. The facility is a central component of the Vakhsh Cascade, a series of planned hydroelectric power plants that aim to maximize the energy potential of the region's primary water source. With a designed capacity of 3780 MW, the dam is poised to become a major contributor to the national grid, reducing reliance on imported energy and providing a stable power supply for domestic consumption and industrial growth (per project specifications).
Regional Energy Independence
Tajikistan's energy landscape is heavily dependent on hydropower, making the completion of the Rogun Dam critical for achieving greater energy independence. The project is situated 110 km from Dushanbe, positioning it to efficiently transmit power to the capital and surrounding regions. By harnessing the flow of the Vakhsh River, the dam will help mitigate seasonal energy shortages, which have historically affected the country's economic output. The operational status of the dam is currently under construction, with initial commissioning phases beginning in 2018, marking a significant milestone in the long-term development plan (according to construction timelines).
Strategic Infrastructure
The Rogun Dam is not merely a national asset but also a key element in the broader regional hydroelectric infrastructure. Its role in the Vakhsh Cascade highlights the integrated approach to water management and energy production in southern Tajikistan. The embankment design of the dam is tailored to the specific geological and hydrological conditions of the Vakhsh River, ensuring durability and efficiency. As the project progresses, it is expected to strengthen Tajikistan's position as a potential energy exporter, enhancing regional connectivity and trade dynamics. The significance of the dam extends beyond electricity generation, influencing water resource management and agricultural planning in the basin.
How did international tensions affect the project?
The construction of the Roghun Dam has been deeply intertwined with regional geopolitics, particularly the long-standing water disputes between Tajikistan and Uzbekistan. As an embankment dam under construction on the Vakhsh River in southern Tajikistan, the project is situated 110 km from Dushanbe and forms a critical component of the planned hydroelectric power plants of Vakhsh Cascade. The primary source of tension stemmed from Uzbekistan's concern that the dam's reservoir would significantly reduce downstream water flow, which is vital for Uzbekistan's cotton crops. This geopolitical conflict raised questions about the sustainability of the water management strategy in the Aral Sea basin and the economic viability of the project for neighboring states.
World Bank Assessments
To address these international concerns, the World Bank conducted a comprehensive Techno-Economic Assessment Study (TEAS) and an Environmental and Social Impact Assessment (ESIA). These studies were designed to evaluate the technical feasibility and the broader socio-environmental consequences of the dam. The assessments provided a framework for understanding how the dam's operation would impact downstream water availability and ecological balance. The findings of the TEAS and ESIA were instrumental in shaping the dialogue between the two nations, offering data-driven insights into the potential trade-offs between energy production in Tajikistan and agricultural needs in Uzbekistan.
De-escalation in 2018
The geopolitical tensions surrounding the Roghun Dam saw a notable de-escalation in 2018. This period marked a shift in the diplomatic relationship between Tajikistan and Uzbekistan, leading to a more collaborative approach to water resource management. The de-escalation allowed for continued progress on the dam, which is currently under construction with a capacity of 3780 MW. The resolution of some of the key disputes helped to stabilize the investment climate and facilitated further international engagement with the project. This development underscores the importance of regional cooperation in managing shared water resources and highlights the potential for hydroelectric infrastructure to serve as both a source of conflict and a catalyst for diplomatic progress.
What are the financial challenges of the Rogun Dam?
The construction of the Rogun Dam has been characterized by significant financial complexities, relying on a mix of domestic capitalization, international contracting, and strategic investment to sustain progress on the Vakhsh River project. The funding landscape for this major hydroelectric infrastructure has evolved through distinct phases, reflecting both the scale of the engineering challenge and the economic strategies of Tajikistan.
Initial Capitalization and the 2010 IPO
Early financing efforts included a notable initial public offering (IPO) in 2010, which raised US$184 million. This capital injection was a critical step in mobilizing funds for the Rogun Hydroelectric Power Plant, helping to cover initial costs and demonstrate market confidence in the project's viability. The IPO served as a foundational financial mechanism, providing liquidity for early-stage construction activities and administrative overhead before larger contractual obligations were fully realized.
Major Contracting and Cost Breakdown
In 2016, a pivotal financial milestone was reached with the signing of a contract with the Italian construction firm Salini Impregilo. This agreement was valued at $3.9 billion, representing one of the largest single contracts in the project's history. The scope of this contract covered extensive civil works and engineering tasks necessary for the embankment dam structure.
Within the broader financial framework, specific components of the dam have distinct cost allocations. The rockfill dam component, a critical structural element of the Rogun Dam, was associated with a cost of $1.95 billion. This figure highlights the significant capital required for the primary barrier structure, which is essential for regulating the Vakhsh River and generating the planned capacity. The financial burden of the rockfill section underscores the technical demands of constructing a large-scale embankment dam in the southern Tajikistan terrain, located 110 km from Dushanbe.
These financial arrangements reflect the ongoing effort to complete the Rogun Dam, which remains under construction as part of the Vakhsh Cascade of hydroelectric power plants. The combination of the 2010 IPO proceeds and the substantial 2016 contract with Salini Impregilo illustrates the multi-layered funding strategy employed to advance the project toward its operational goals.
Current Status and Future Prospects
The Roghun Dam project represents a significant infrastructure undertaking in southern Tajikistan, currently maintaining an operational status of under_construction. The facility is designed as an embankment dam situated on the Vakhsh River, forming a critical component of the planned hydroelectric power plants of the Vakhsh Cascade. Located approximately 110 km from Dushanbe, the project aims to harness water resources to generate a total capacity of 3780 MW. The development timeline includes key milestones such as the official launch in 2016, which marked a renewed phase of activity for the long-planned scheme. Subsequent years saw the commissioning of initial units in 2018 and 2019, signaling early operational achievements despite the broader project remaining in the construction phase.
Construction Progress and Technical Developments

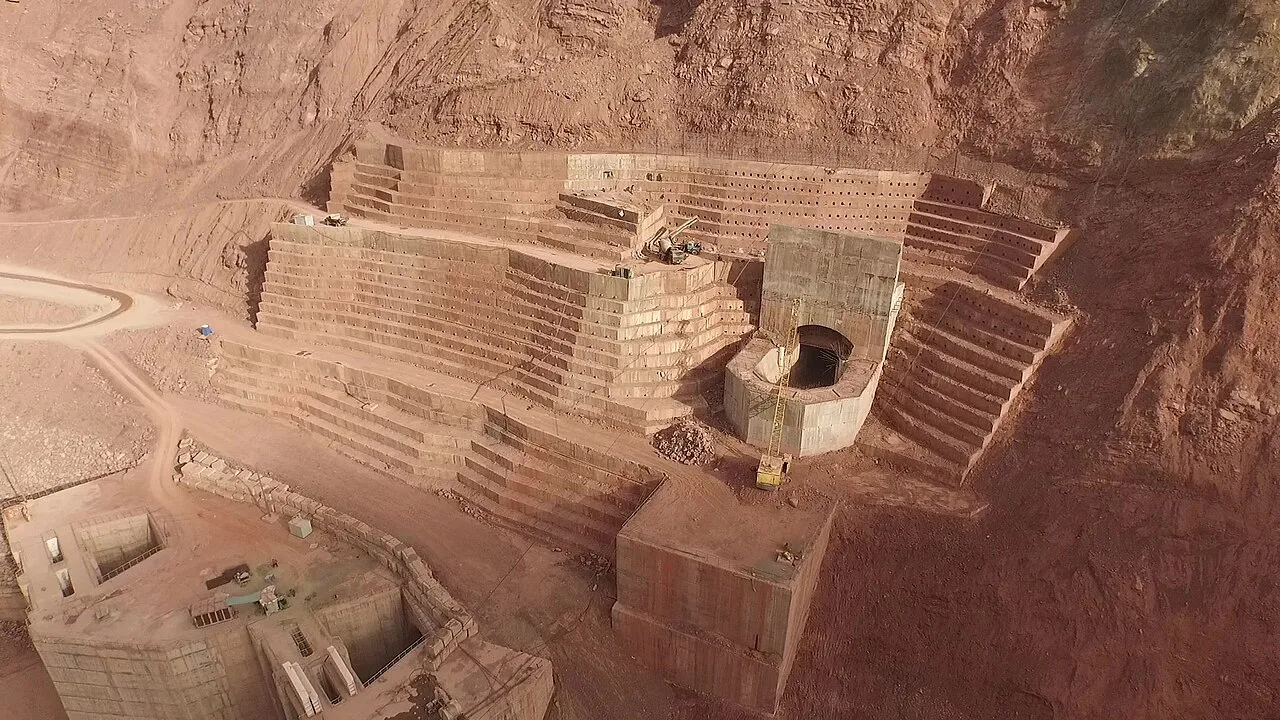

Recent developments highlight the physical progression of the dam structure itself. In 2022, concrete pouring commenced on the main dam core, a critical engineering step that influences the stability and water-retention capabilities of the embankment design. This phase follows the initial unit commissions and reflects the ongoing effort to complete the main structural elements required for full capacity utilization. The project continues to advance through these technical stages, with the embankment construction being central to the dam's functionality. The Vakhsh River provides the primary water source, and the dam's position within the Vakhsh Cascade allows for integrated energy management in the region. The operator of the facility is, though the national significance of the 3780 MW output suggests coordinated management. The construction efforts in 2022 on the main core represent a tangible advancement from the earlier commissioning of units, moving the project closer to its full hydroelectric potential. The timeline from the 2016 launch through the 2022 concrete pouring demonstrates a sustained commitment to completing this major energy infrastructure asset in Tajikistan.
