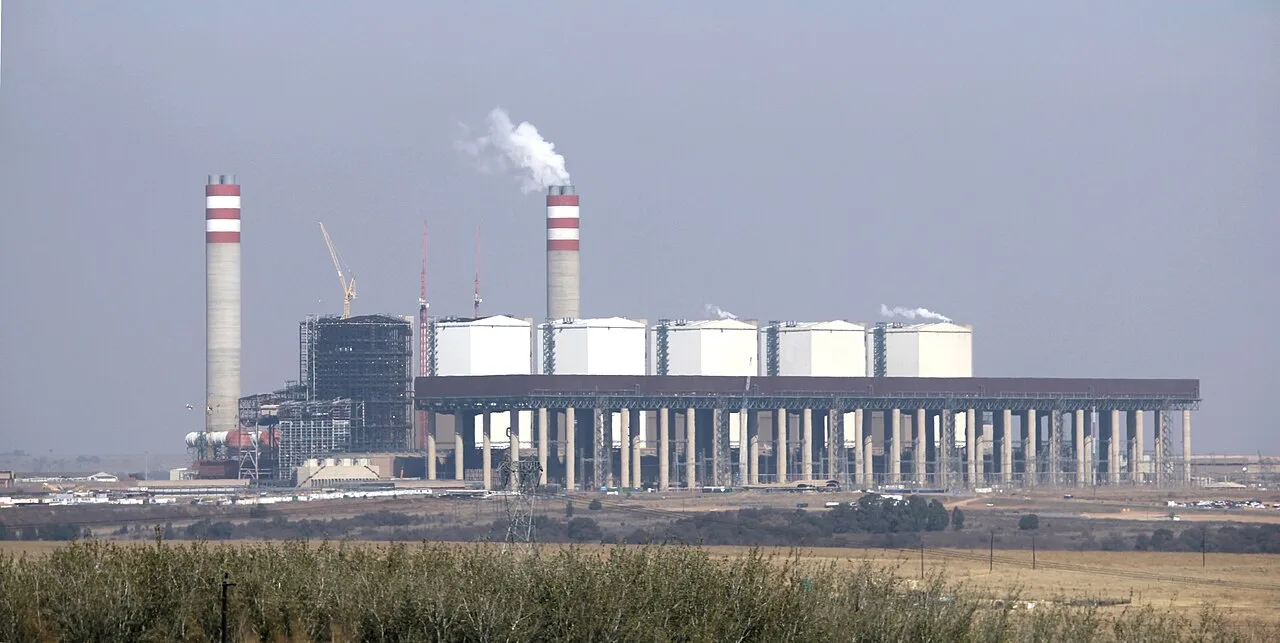

Kusile Power Station is a major coal-fired power plant located in the province of Mpumalanga, South Africa. The facility is situated within the Victor Khanye Local Municipality, placing it in one of the country's primary energy-producing regions. As a critical component of the national energy infrastructure, the station is owned and operated by Eskom, the state-owned power utility that manages the majority of South Africa's electricity generation capacity. The plant represents a significant investment in the country's baseload power supply, designed to meet the growing energy demands of the region and the broader national grid.

The power station is configured with six generating units, each with a nameplate capacity of 800 MW. This configuration brings the total installed capacity of the Kusile Power Station to 4,800 MW. The facility is currently operational, contributing substantially to Eskom's overall generation portfolio. The scale of the plant underscores its importance in the South African energy mix, providing a reliable source of electricity derived from coal, which remains the dominant fuel source for power generation in the country.

The development of Kusile Power Station is part of Eskom's broader strategy to expand generation capacity to mitigate load shedding and ensure grid stability. Located in Mpumalanga, the plant benefits from the province's extensive coal reserves, facilitating efficient fuel supply logistics. The operational status of the station reflects the culmination of extensive construction and commissioning phases, with the plant officially commissioned in 2017. This timeline aligns with the strategic timing required to bring new capacity online to support the economic activities of the region and the nation.

Why it matters

Kusile Power Station holds a distinct, often contentious place in global energy infrastructure history as one of the most expensive coal-fired power plants ever constructed. The project’s significance extends beyond its 4,800 MW installed capacity, which is derived from six 800 MW generating units operated by Eskom. It serves as a primary case study in the financial risks associated with large-scale thermal power development in emerging economies. The station is widely cited in energy economics literature for its severe budget overruns, which transformed it into a financial anchor for South Africa’s state-owned power utility. These cost escalations have drawn intense scrutiny from analysts, journalists, and policymakers examining the viability of new coal investments in an era of rising renewable energy competitiveness.

Comparative Context with Medupi

The financial narrative of Kusile is inextricably linked to its sister plant, Medupi. Both stations were commissioned as part of Eskom’s strategy to expand the National Electricity Supply System in the Mpumalanga province. However, Kusile’s construction timeline and cost dynamics have often been compared directly with Medupi to illustrate the compounding challenges of parallel mega-projects. While both facilities share similar technical specifications, the operational and financial trajectories have highlighted systemic issues in project management and procurement. The delays and cost blowouts at Kusile have had a ripple effect on South Africa’s broader energy policy, influencing debates on load-shedding mitigation and the optimal mix of base-load power generation.

Implications for Global Coal Investment

Beyond South Africa, Kusile serves as a cautionary tale for international energy investors. The project demonstrates how initial capital expenditure estimates can diverge significantly from final accounts due to inflation, labor disputes, and technical integration challenges. As the global energy sector transitions, the high capital intensity of Kusile underscores the economic pressures facing traditional coal assets. The plant’s operational status, commissioned in 2017, marks the beginning of its revenue-generating phase, but the debt burden associated with its construction continues to influence Eskom’s financial health and tariff structures. This context is critical for engineers and analysts evaluating the levelized cost of energy for new coal projects versus alternative technologies.

How did the construction timeline unfold?

Construction of the Kusile Power Station began in 2007, marking a significant expansion in South Africa's coal-fired generation capacity. The project, owned and operated by Eskom in Mpumalanga, was designed to house six generating units, each with a nameplate capacity of 800 MW, totaling 4,800 MW. The station is currently operational, with the primary commissioning milestone recorded in 2017.

Year Event
2007 Construction begins on the Kusile Power Station in Mpumalanga, South Africa.
2017 Kusile Power Station is commissioned, bringing its 6 generating units (800 MW each) online for a total capacity of 4,800 MW.

The development of Kusile represents one of the major infrastructure efforts by Eskom to augment the national grid. The plant’s six units, each rated at 800 MW, contribute to the total installed capacity of 4,800 MW. While the initial construction phase started in 2007, the full operational status was achieved with the commissioning in 2017. The station remains a key asset in South Africa’s energy mix, utilizing coal as its primary fuel source.

What caused the significant delays and technical defects?

The development of Kusile Power Station was characterized by significant deviations from initial projections, driven by a convergence of technical complexities, supply chain disruptions, and management challenges. While the station is operational with a total installed capacity of 4,800 MW, the path to commissioning in 2017 involved prolonged delays that impacted South Africa’s broader energy infrastructure timeline.

Technical Defects and Design Challenges

The adoption of this specific unit size introduced technical complexities, particularly regarding the boiler design and auxiliary systems. Reports indicate that the boiler design faced scrutiny, with issues related to heat transfer surfaces and structural integrity emerging during the construction phase. These defects required extensive engineering revisions and on-site modifications, which slowed the progress of the individual units.

Additionally, the integration of environmental control systems presented significant hurdles. The flue gas desulphurisation (FGD) units and fabric filters were critical components for meeting emission standards. However, the FGD systems experienced delays due to manufacturing bottlenecks and installation errors. The fabric filters, essential for particulate matter removal, also faced supply chain issues, with some units arriving later than scheduled. These technical failures necessitated extended testing and commissioning periods, further pushing back the overall timeline.

Labor Disputes and Management Issues

Labor relations played a crucial role in the station’s development. As the primary operator, Eskom faced numerous labor disputes that disrupted construction activities. Strikes and negotiations with various unions led to intermittent work stoppages, affecting the progress of civil works and mechanical installations. These disputes were often linked to broader issues within Eskom, including wage negotiations and job security concerns, which spilled over into the Kusile project.

Management and corruption allegations also contributed to the delays. Investigations into Eskom’s procurement processes revealed inefficiencies and potential mismanagement, which impacted the timely delivery of critical components. The complexity of coordinating multiple contractors and suppliers exacerbated these issues, leading to a fragmented approach to project execution. Despite these challenges, the station was eventually commissioned in 2017, marking a significant milestone in South Africa’s coal-fired power generation capacity.

What is the environmental impact and emissions profile?

Kusile Power Station operates as a major source of carbon emissions within South Africa’s energy mix, driven by its substantial installed capacity of 4,800 MW. As a coal-fired facility, the plant’s environmental footprint is primarily defined by the combustion of hard coal to generate electricity across its six generating units. Each unit contributes 800 MW to the grid, resulting in significant annual output that directly correlates with greenhouse gas emissions. The operational status of the plant means it is actively burning fossil fuels, contributing to the atmospheric concentration of carbon dioxide and other byproducts typical of thermal power generation in the Mpumalanga province.

Emissions and Flue Gas Desulphurisation

The environmental profile of Kusile includes the implementation of flue gas desulphurisation (FGD) technology to mitigate air pollution. This system is designed to remove sulfur dioxide from the exhaust flue gases of fossil-fuel power plants. The FGD process is critical for reducing acid rain precursors and improving local air quality in the surrounding region. However, the primary emission remains carbon dioxide, which accumulates as the plant operates at or near its nameplate capacity. The scale of the station, with its six large units, ensures that even with desulphurisation, the volume of CO2 released is substantial, impacting both local and regional climate metrics.

Greenpeace Protests and Public Response

The construction and operation of Kusile Power Station have drawn significant attention from environmental groups, most notably Greenpeace. Protests have highlighted concerns over the long-term carbon lock-in associated with such a large coal investment. Activists have argued that the plant’s size and fuel type may hinder South Africa’s ability to meet future climate targets. These demonstrations reflect broader debates about the sustainability of coal energy in the region. The visibility of the protests underscores the tension between immediate energy security needs and long-term environmental goals. Public scrutiny continues to influence how the operator, Eskom, manages the plant’s environmental reporting and community relations.

What corruption controversies surrounded the project?

The development of the Kusile Power Station was marked by significant financial and governance controversies, particularly concerning procurement processes and executive compensation structures within Eskom. These issues drew international scrutiny and regulatory action, notably involving major equipment suppliers and internal management.

ABB and SEC Charges

One of the most prominent legal challenges involved ABB Ltd, a Swiss-Swedish multinational corporation that supplied critical boiler technology for the project. The U.S. Securities and Exchange Commission (SEC) brought charges against ABB, alleging that the company had engaged in a series of corrupt payments to secure and maintain the contract for the Kusile and Medupi power stations. According to SEC filings, ABB paid millions of dollars in bribes to Eskom executives and consultants to influence the selection of its boilers over competitors. These payments were often channeled through third-party consultants, obscuring the flow of funds and complicating the audit trail. The SEC charges highlighted systemic weaknesses in Eskom’s procurement framework, suggesting that technical merit was sometimes secondary to financial incentives for key decision-makers. ABB ultimately settled with the SEC, acknowledging that its internal controls had failed to detect and prevent the irregular payments, which were intended to ensure the continued supply of parts and favorable contract terms.

Hitachi and Corrupt Payments

Hitachi, another major supplier involved in the project, also faced allegations of corrupt payments. Investigations revealed that Hitachi had engaged in financial arrangements with Eskom consultants and executives to secure its share of the turbine and generator contracts. These payments were structured to resemble consulting fees or performance bonuses, but were later characterized as strategic bribes designed to lock in long-term service agreements and favorable pricing. The involvement of Hitachi underscored the competitive pressure among international suppliers, where financial leverage was used to navigate Eskom’s complex and sometimes opaque decision-making processes. Regulatory bodies noted that these practices distorted the market, potentially leading to higher costs for the South African state utility and, by extension, the national electricity tariff.

Eskom Executive Slush Fund Scandal

Internally, Eskom executives were implicated in a "slush fund" scandal that further eroded public trust in the utility’s management of the Kusile project. Reports indicated that a portion of the funds generated from supplier payments and consultant fees were diverted into an informal reserve, often referred to as a slush fund. This fund was used to reward key executives, finance travel, and cover miscellaneous expenses that were not always fully documented in the official budget. The existence of this slush fund suggested a culture of financial flexibility that bordered on opacity, with executives leveraging their positions to extract value from the massive capital expenditure required for the Kusile station. The scandal contributed to broader questions about governance at Eskom, prompting internal audits and parliamentary inquiries that sought to trace the flow of money from suppliers to executive bank accounts. These revelations highlighted the need for stricter oversight mechanisms in large-scale energy infrastructure projects in South Africa.
