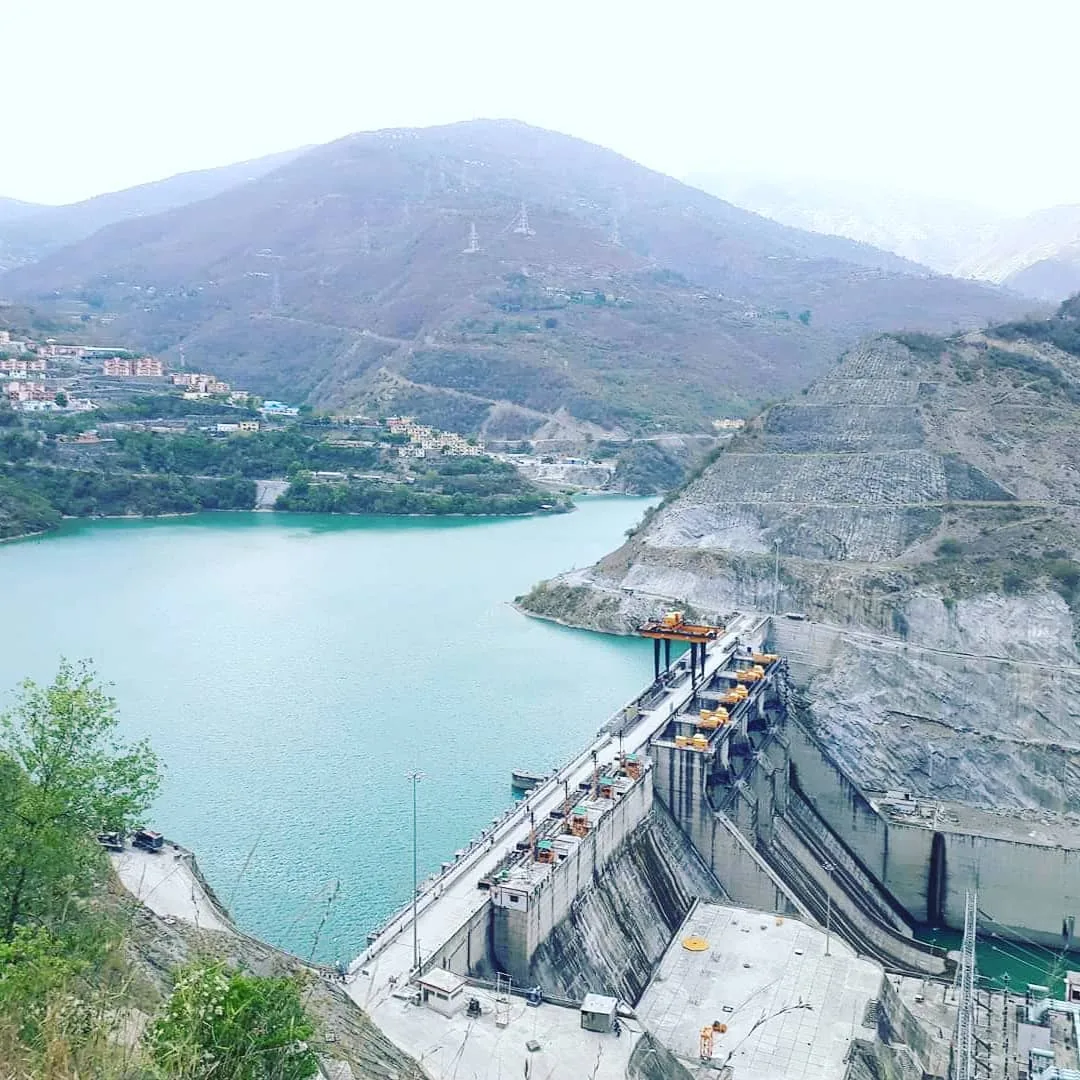

Overview
The Koteshwar Dam is a gravity dam situated on the Bhagirathi River in the Tehri District of Uttarakhand, India. It is a critical component of the broader Tehri Hydropower Complex, positioned approximately 22 km downstream from the main Tehri Dam. The facility serves multiple strategic functions within the regional energy and water management infrastructure. Primarily, it regulates the tailrace of the Tehri Dam to optimize irrigation flows and acts as the lower reservoir for the Tehri Pumped Storage Power Station. In addition to its regulatory and storage roles, the dam houses a 400 MW run-of-the-river power station, contributing significantly to the hydropower output of the complex.
Project Approval and Construction Challenges
The Koteshwar Dam project received formal approval in 2000, marking the beginning of a construction phase characterized by both rapid progress and significant geological and hydrological challenges. The construction site experienced severe inundation during floods in September 2010, which temporarily halted work and impacted infrastructure. Further complications arose in December 2010 when the diversion tunnel was blocked due to the heaving and collapse of the surrounding hillside. Despite these setbacks, the project maintained a relatively tight commissioning schedule for its initial phases.
Commissioning and Operational Status
The dam reached key operational milestones in the early 2010s. The spillway was commissioned in January 2011, allowing for effective water flow management. The first generator of the 400 MW power station was commissioned on 27 March 2011, followed closely by the second generator on 30 March 2011. The final two generators were made operational in March 2012, completing the full capacity installation. The facility remains operational, continuing to support the integrated functions of the Tehri Hydropower Complex, including power generation, irrigation regulation, and pumped storage operations.
Why it matters
The Koteshwar Dam functions as a critical infrastructure node within the broader Tehri Hydropower Complex, providing essential regulatory and storage capabilities that enhance the efficiency of the entire system. Located 22 km downstream of the primary Tehri Dam on the Bhagirathi River in Uttarakhand, India, this gravity dam is not merely an add-on but a strategic component designed to optimize water management for both power generation and agricultural needs. Its primary operational role involves regulating the tailrace of the Tehri Dam, ensuring a consistent and manageable flow of water for downstream irrigation projects. This regulation is vital for stabilizing water availability for agricultural regions that depend on the Bhagirathi River, mitigating the variability that often characterizes monsoon-fed river systems. Furthermore, the Koteshwar Dam serves as the lower reservoir for the Tehri Pumped Storage Power Station. In pumped storage systems, the lower reservoir acts as a flexible energy buffer, allowing water to be pumped back up to the upper reservoir during periods of low electricity demand and released during peak hours. By creating this lower reservoir, the Koteshwar Dam enables the Tehri Complex to function with greater operational flexibility, effectively turning the hydropower system into a giant battery for the regional grid. This capability is increasingly important for balancing the load on the Northern Grid of India, allowing for more efficient utilization of the primary Tehri Dam’s capacity. In addition to its regulatory and storage functions, the dam houses a 400 MW run-of-the-river power station. This capacity represents a significant contribution to the regional power supply, adding substantial generating potential to the Tehri District. The project was approved in 2000, with the first generator commissioned on 27 March 2011, followed by the second on 30 March 2011. The construction process faced notable challenges, including inundation by floods in September 2010 and a diversion tunnel blockage due to hill heaving in December 2010. Despite these setbacks, the spillway was commissioned in January 2011, and the final generators became operational in March 2012. The successful integration of the 400 MW capacity underscores the dam's role in boosting the energy output of the Tehri Hydropower Complex, making it a key asset for energy security in Uttarakhand and the surrounding northern Indian states.Engineering design and specifications
The Koteshwar Dam is a gravity structure located on the Bhagirathi River, serving as a critical component of the Tehri Hydropower Complex. Its primary engineering function is to regulate the tailrace of the upstream Tehri Dam for irrigation purposes and to form the lower reservoir for the Tehri Pumped Storage Power Station. The facility also houses a 400 MW run-of-the-river power station.
Structural Dimensions and Specifications
The dam features a gravity design with a total height of 97.5 m and a crest length of 300 m. Specific details regarding the structural volume and crest elevation are not explicitly detailed in the primary cited sources. The spillway was commissioned in January 2011, following the inundation of the construction site by floods in September 2010 and subsequent geological challenges involving the heaving and collapse of the hill blocking the diversion tunnel in December 2010.
| Parameter | Value |
|---|---|
| Dam Type | Gravity Dam |
| Height | 97.5 m |
| Crest Length | 300 m |
| Structural Volume | [?] |
| Crest Elevation | [?] |
| Spillway Gate Dimensions | [?] |
| Discharge Capacity | [?] |
The power station integrated into the dam has an installed capacity of 400 MW. The commissioning of the generators occurred in phases. The first generator became operational on 27 March 2011, followed by the second on 30 March 2011. The final two generators were made operational in March 2012. The project received approval in 2000.
Hydrology and reservoir characteristics
The Koteshwar Dam operates within the hydrological framework of the Bhagirathi River, situated in the Tehri District of Uttarakhand, India. The dam is a critical component of the Tehri Hydropower Complex, positioned approximately 22 km downstream from the main Tehri Dam structure. Its primary hydrological function is to regulate the tailrace of the upstream Tehri Dam, thereby managing water flow for both irrigation purposes and the operational requirements of the Tehri Pumped Storage Power Station. The reservoir created by the Koteshwar Dam serves as the lower reservoir for this pumped storage system, playing a vital role in the energy dynamics of the region. The catchment area feeding into the Koteshwar reservoir is extensive, covering 7,691 km2. This substantial drainage basin collects runoff from the surrounding Himalayan terrain, ensuring a consistent water supply to the run-of-the-river power station and the pumped storage facility.
Reservoir Capacity and Storage Dynamics
The reservoir characteristics of the Koteshwar Dam are defined by its total and active storage capacities. The total reservoir capacity is 88,900,000 m3, providing a significant volume for water retention. Of this total volume, the active storage capacity is 35,000,000 m3. This active storage is crucial for the operational flexibility of the hydroelectric system, allowing for the regulation of water flow to meet varying energy demands and irrigation needs. The reservoir functions by drawing the lake level down by 30 m from the full pool elevation to utilize this active storage. This drawdown mechanism enables the efficient operation of the 400 MW run-of-the-river power station, ensuring that water is released at optimal times for power generation. The interplay between the total capacity and the active storage allows the dam to manage fluctuations in water inflow, particularly during the monsoon seasons and dry periods. The design of the reservoir ensures that the water levels can be controlled precisely, supporting the dual objectives of power generation and irrigation regulation.
Hydrological Challenges and Infrastructure
The hydrological environment of the Koteshwar Dam has presented several challenges during its construction and operation. In September 2010, the construction site was inundated by significant floods, which impacted the progress of the project. These floods highlighted the dynamic nature of the Bhagirathi River and the need for robust flood management strategies. Additionally, in December 2010, the diversion tunnel was blocked due to the heaving and collapse of the surrounding hill, further complicating the construction process. Despite these challenges, the spillway was successfully commissioned in January 2011, marking a significant milestone in the dam's operational readiness. The ability to manage such hydrological events is essential for the long-term sustainability of the dam and its role in the Tehri Hydropower Complex. The reservoir's design and the dam's structural integrity have been tested by these events, demonstrating the resilience of the infrastructure in the face of natural hydrological variations.
Power generation infrastructure
The Koteshwar Dam integrates a significant run-of-the-river power station situated on the right bank of the Bhagirathi River. This facility is an integral component of the broader Tehri Hydropower Complex, designed to optimize energy extraction from the regulated tailrace of the upstream Tehri Dam. The power station has an installed capacity of 400 MW, contributing substantially to the regional grid while serving the dual purpose of irrigation regulation and creating the lower reservoir for the Tehri Pumped Storage Power Station.
Turbine and Generator Configuration
The electrical output is generated through four identical Francis turbine-generator sets. Each unit is rated at 100 MW, collectively delivering the plant's total 400 MW capacity. The selection of Francis turbines is characteristic of medium-head hydroelectric installations, offering high efficiency across a range of flow conditions typical of the Bhagirathi River's discharge patterns. The turbines are driven by the hydraulic head available between the dam's reservoir level and the tailwater elevation. The maximum hydraulic head for the power station is 75 m, a parameter that dictates the specific speed and design geometry of the runner blades to maximize energy conversion efficiency.
Operational Mechanics and Commissioning
The power house operates by channeling water from the reservoir through penstocks to the turbine runners. As water strikes the blades, the kinetic and potential energy is converted into mechanical rotation, which drives the generator to produce electricity. The operational timeline of the facility reflects the complex construction environment of the Tehri District. The first generator was commissioned on 27 March 2011, followed closely by the second on 30 March 2011. The spillway was also commissioned in January 2011, ensuring flow regulation during the initial power generation phase. The final two generators were made operational in March 2012, completing the full 400 MW capacity.
Construction faced significant geological and hydrological challenges that influenced the operational startup. In September 2010, the construction site was inundated by floods, and in December 2010, the diversion tunnel was blocked due to the heaving and collapse of the adjacent hill. These events required rapid engineering responses to maintain the critical path for the 2011 commissioning schedule. The dam's location, 22 km downstream of the Tehri Dam, allows it to capture the tailrace flow efficiently, minimizing transmission losses within the complex. The run-of-the-river nature of the station means that power generation is directly correlated with the instantaneous flow rate of the Bhagirathi River, modulated by the release schedules from the upstream Tehri reservoir.
Construction history and operational milestones
The Koteshwar Dam project was formally approved in 2000, initiating a construction phase characterized by significant geological and hydrological challenges. As a gravity dam on the Bhagirathi River, the structure is integral to the Tehri Hydropower Complex, specifically designed to regulate the tailrace of the Tehri Dam and form the lower reservoir for the Tehri Pumped Storage Power Station. The construction timeline reveals a series of critical milestones and interruptions that defined the project's progression from approval to full operational status.
Construction Challenges and Early Milestones
Construction faced severe disruptions in the latter part of 2010. In September 2010, the construction site was inundated by floods, significantly impacting progress. This was followed by a major geological event in December 2010, when the diversion tunnel was blocked due to the heaving and collapse of the adjacent hill. Despite these setbacks, the project advanced rapidly into the following year. The spillway was successfully commissioned in January 2011, marking a key infrastructure completion before the main power generation units came online.
Generator Commissioning Timeline
The power station, with a total capacity of 400 MW, features a run-of-the-river configuration. The commissioning of the generators occurred in two distinct phases. The first generator was commissioned on 27 March 2011, followed immediately by the second generator on 30 March 2011. These initial units brought the plant into early operational status. However, full capacity was not achieved until the following year. The last two generators were made operational in March 2012, completing the installation phase for the 400 MW facility.
| Year | Event |
|---|---|
| 2000 | Project approval |
| September 2010 | Construction site inundated by floods |
| December 2010 | Diversion tunnel blocked due to hill heaving/collapse |
| January 2011 | Spillway commissioned |
| 27 March 2011 | First generator commissioned |
| 30 March 2011 | Second generator commissioned |
| March 2012 | Last two generators made operational |
How does the Koteshwar Dam integrate with the Tehri Hydropower Complex?
The Koteshwar Dam functions as a critical downstream component of the Tehri Hydropower Complex, situated 22 km downstream of the primary Tehri Dam on the Bhagirathi River in Uttarakhand, India. Its primary engineering purpose is to regulate the tailrace of the upstream Tehri Dam, thereby optimizing water flow for both irrigation and power generation. This strategic positioning allows the complex to manage the hydraulic head more efficiently, ensuring that the water released from the main reservoir is utilized effectively before re-entering the river system.
Lower Reservoir for Pumped Storage
A key function of the Koteshwar Dam is the creation of the lower reservoir for the Tehri Pumped Storage Power Station. This pumped storage facility enhances the flexibility of the regional power grid by allowing water to be pumped back up to the upper reservoir during periods of low electricity demand and released during peak hours. The dam’s structure maintains the necessary water levels in this lower reservoir, enabling the synergy between the two dams to maximize energy output. This integration is vital for balancing the variable load on the grid and improving the overall efficiency of the hydropower system.
Run-of-the-River Power Generation
In addition to its role in the pumped storage system, the Koteshwar Dam hosts a 400 MW run-of-the-river power station. This facility generates electricity by harnessing the natural flow of the Bhagirathi River, complementing the output of the main Tehri Dam. The first generator of this station was commissioned on 27 March 2011, followed by the second on 30 March 2011. The last two generators became operational in March 2012, completing the power station’s initial phase. The spillway was commissioned in January 2011, further enhancing the dam’s ability to manage water flow and protect the infrastructure during high discharge periods.
Construction Challenges and Integration
The integration of the Koteshwar Dam into the Tehri Hydropower Complex faced several construction challenges, including significant flooding in September 2010 that inundated the construction site. Additionally, the diversion tunnel was blocked in December 2010 due to the heaving and collapse of the adjacent hill. Despite these setbacks, the project was approved in 2000 and successfully commissioned, demonstrating the resilience of the engineering efforts. The dam’s ability to regulate the tailrace and support the pumped storage system underscores its importance in the overall functionality of the Tehri Hydropower Complex.
What are the key challenges faced during the construction of Koteshwar Dam?
The construction of the Koteshwar Dam was marked by significant environmental and geotechnical disruptions, primarily driven by the volatile conditions of the Bhagirathi River valley. These challenges directly impacted the project's timeline, causing delays between the initial approval in 2000 and the full commissioning of the power station.
September 2010 Floods
In September 2010, the construction site was severely inundated by floods. This environmental event disrupted ongoing works and required substantial recovery efforts to resume normal construction pace. The flooding demonstrated the vulnerability of the site to seasonal hydrological extremes, a critical factor in the design and operation of the 400 MW run-of-the-river power station.
December 2010 Hill Collapse
Further complications arose in December 2010 when the diversion tunnel became blocked. This blockage was caused by the heaving and collapse of the adjacent hill. The geotechnical instability of the hillside presented a major engineering hurdle, necessitating remedial measures to clear the diversion tunnel and ensure the structural integrity of the surrounding terrain. These events occurred just months before the commissioning of the spillway in January 2011.
Impact on Commissioning Timeline
Despite these setbacks, the project proceeded with the commissioning of the first generator on 27 March 2011 and the second on 30 March 2011. However, the full operational capacity was not achieved immediately. The last two generators were made operational in March 2012, indicating that the construction challenges extended the finalization of the power station's capacity by approximately one year.
See also
- Pavagada Solar Park: Development, Land Lease Model, and Operational History
- Kurnool Ultra Mega Solar Park: Development, Infrastructure, and Operational Profile
- Tehri Dam: Engineering, Operations and Environmental Impact
- Tata Power: Corporate History, Operations and Strategic Expansion
- NTPC Limited: Corporate Structure, Operations and Strategic Expansion
