Overview

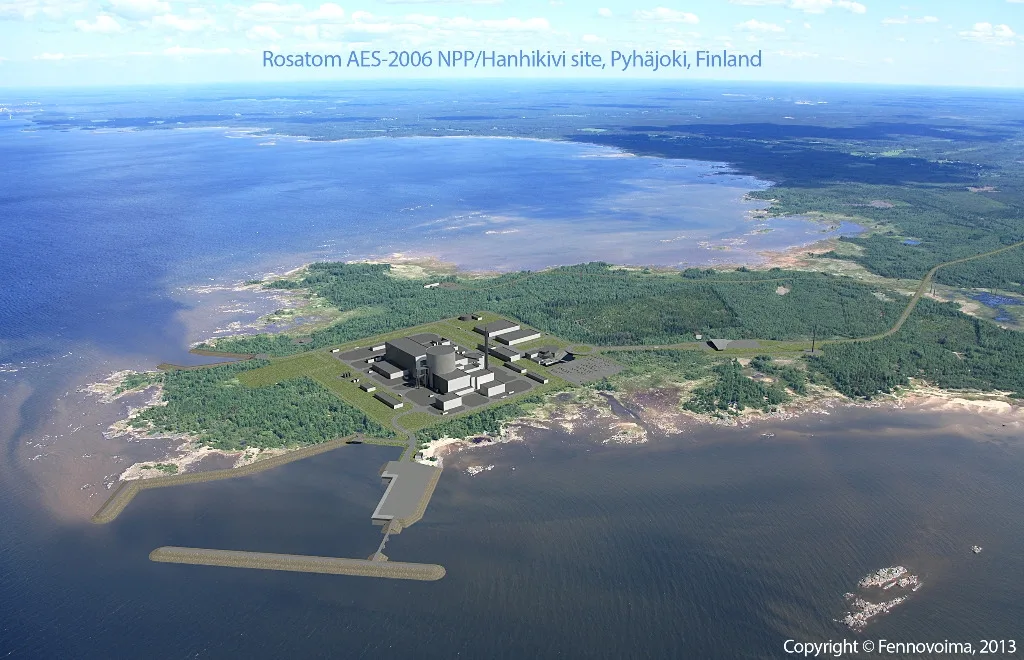

The Hanhikivi Nuclear Power Plant was a major energy infrastructure project located on the Hanhikivi peninsula within the municipality of Pyhäjoki, Finland. The initiative aimed to construct a single nuclear generating unit to bolster the nation's electricity supply. The project was developed by the power company Fennovoima, which served as the primary operator for the venture. The planned facility was designed to house one Russian-designed VVER-1200 pressurised water reactor. This specific reactor technology was selected to provide a capacity of 1200 MW. The project was estimated to supply 10% of Finland's energy demand by 2024, highlighting its potential significance in the national grid mix.
Project Timeline and Cancellation
In April 2021, Fennovoima announced a detailed construction schedule for the Hanhikivi plant. The company stated that construction activities would begin in 2023. Furthermore, commercial operation was projected to start in 2029. These timelines indicated a relatively rapid development phase for a nuclear facility of this scale. However, the geopolitical landscape shifted significantly in the following year. In May 2022, the Russian invasion of Ukraine created substantial uncertainty for energy projects involving Russian technology and financing.
In response to these geopolitical developments, Fennovoima terminated its contract with Rosatom, the state-owned nuclear energy corporation responsible for building the power plant. This decision effectively halted the Hanhikivi project. The termination marked the end of the immediate plans to construct the VVER-1200 reactor at the Pyhäjoki site. The cancellation reflects the broader impact of international relations on energy infrastructure development in Northern Europe. The project remains listed as cancelled, with the 1200 MW capacity never realized. The Hanhikivi case illustrates the vulnerabilities of cross-border energy dependencies during periods of geopolitical tension.
Project Origins and Corporate Structure
The Hanhikivi Nuclear Power Plant project was initiated by Fennovoima Oy, a Finnish limited company established in 2007 to develop and operate the facility. The operator was formed as a consortium comprising 67 diverse companies, ranging from industrial giants to smaller regional enterprises, aiming to leverage collective investment and expertise for the construction of the plant on the Hanhikivi peninsula in the municipality of Pyhäjoki. The corporate structure was designed to share the financial and technical risks associated with the first new nuclear build in Finland in decades.
The project received its initial political backing in 2010 when the Finnish Government granted a "decision-in-principle" for the plant. This governmental endorsement was subsequently approved by the Finnish Parliament, providing the regulatory foundation for the project's progression. The approval signaled strong national support for expanding nuclear capacity to ensure energy security and diversify the generation mix.
A critical phase in the project's development involved the selection of the reactor technology and the main contractor. Fennovoima evaluated proposals from several international competitors, including Areva and Toshiba, before ultimately selecting the Russian state-owned nuclear energy corporation, Rosatom. The chosen technology was the AES-2006 generation, featuring the VVER-1200 pressurised water reactor design. This reactor type was specified to have an electrical capacity of 1200 MW. The selection of Rosatom and the VVER-1200 design was a strategic decision that would later become central to the project's geopolitical challenges, particularly following the Russian invasion of Ukraine in 2022, which led Fennovoima to terminate its contract with Rosatom.
Technical Specifications and Supply Chain
The Hanhikivi Nuclear Power Plant project was designed around a single Russian VVER-1200 pressurised water reactor (PWR). This reactor type is a third-generation design with a net electrical capacity of 1200 MW. The choice of the VVER-1200 was central to the project's technical identity, relying on the established engineering standards of the Russian nuclear industry. The plant was intended to contribute significantly to Finland's energy mix, with estimates suggesting it could supply 10% of the national energy demand upon completion.
Primary Contract and Turbine Package
The core construction contract was awarded to Rosatom Overseas in 2013. This agreement positioned the Russian state atomic energy corporation as the primary builder and supplier of the nuclear island. In 2016, the project secured the turbine generator package through a contract with Alstom Power Systems, which was part of General Electric at the time. This partnership was crucial for integrating the steam turbine systems with the Russian reactor design, ensuring compatibility between the nuclear island and the conventional island.
Automation and Secondary Suppliers
The automation systems underwent several changes during the pre-construction phase. In 2017, Rolls-Royce and Schneider Electric were selected as the initial automation suppliers. However, Rolls-Royce withdrew from the project in 2018. Following this departure, Framatome and Siemens were selected in 2019 to take over the automation supply roles. These shifts in the supply chain reflected the complex international partnerships required for the project.
| Supplier | Role | Year |
|---|---|---|
| Rosatom Overseas | Primary Contractor / Nuclear Island | 2013 |
| Alstom Power Systems (GE) | Turbine Generator Package | 2016 |
| Rolls-Royce | Automation Supplier (Initial) | 2017 |
| Schneider Electric | Automation Supplier (Initial) | 2017 |
| Framatome | Automation Supplier (Subsequent) | 2019 |
| Siemens | Automation Supplier (Subsequent) | 2019 |
The termination of the contract with Rosatom in May 2022, following the Russian invasion of Ukraine, effectively ended the supply chain arrangements established over the preceding decade. The VVER-1200 design and its associated supplier network remained unutilized for the Hanhikivi site.
Financing and Ownership
The Hanhikivi Nuclear Power Plant project reached a critical financial milestone in 2014 with the announcement of the final investment decision. This decision was pivotal for the advancement of the plant, which was planned to house one Russian-designed VVER-1200 pressurised water reactor with a capacity of 1200 MW. The financial structure relied heavily on the participation of Voimaosakeyhtiö SF, a key entity in the ownership and financing framework of the project. The involvement of such partners was essential to secure the necessary capital for the construction of the facility on the Finnish Hanhikivi peninsula in the municipality of Pyhäjoki.
Ownership Structure
By 2015, the ownership structure of the project was assured, providing a stable foundation for the subsequent development phases. The secured ownership arrangement was designed to mitigate risks associated with the long construction timeline and the integration of the Russian-designed reactor technology. This structural clarity was intended to facilitate smoother negotiations with lenders and stakeholders, ensuring that the project could progress towards the planned start of construction in 2023.
Cost Estimates and Financing Status
Financial projections for the Hanhikivi plant indicated that the estimated cost of electricity generation would be less than €50 per megawatt-hour (MWh). This cost estimate was a central argument for the economic viability of the project, suggesting that the reactor would supply 10% of Finland's energy demand by 2024 if commissioned on schedule. The debt financing status as of 2017 reflected ongoing efforts to lock in favorable terms based on these cost projections. In May 2022, in the wake of the Russian invasion of Ukraine, Fennovoima terminated its contract with Rosatom to build the power plant. This termination effectively ended the original financing and ownership arrangements tied to the Russian supplier, leading to the eventual cancelled status of the Hanhikivi Nuclear Power Plant project.
Why it matters
The Hanhikivi Nuclear Power Plant project held significant strategic importance for Finland’s energy security, with projections indicating the single VVER-1200 pressurised water reactor would supply 10% of the nation's total energy demand by 2024 (Fennovoima project estimates). This substantial contribution to the national grid underscored the plant's role in diversifying Finland's energy mix and reducing reliance on imported fossil fuels. The operational timeline, with commercial operation targeted for 2029, positioned Hanhikivi as a critical infrastructure asset for meeting mid-century decarbonization goals (Fennovoima, April 2021). The political dimensions of the project were equally complex, particularly concerning Russian involvement. Rosatom, the state-owned Russian nuclear energy corporation, was set to own 34% of the plant and was expected to supply 3% of Finland's electricity output. This level of foreign ownership and energy supply raised concerns about geopolitical leverage and energy independence within the Nordic region. Analysts Veli-Pekka Tynkkynen and Martin Kragh examined these dynamics, highlighting how Russian influence could extend beyond direct energy exports to affect broader Nordic power prices and political stability. Their analysis suggested that the integration of Russian capital and technology into Finland's energy infrastructure created vulnerabilities that could be exploited during periods of diplomatic tension. Furthermore, the project was intertwined with broader European energy market dynamics, including the Fortum-Uniper investment pressure. These financial and political interdependencies illustrated the complex web of interests surrounding nuclear infrastructure in Northern Europe. The termination of the contract with Rosatom in May 2022, following the Russian invasion of Ukraine, marked a pivotal shift in Finland's energy strategy, reflecting the heightened sensitivity to geopolitical risks in energy planning (Fennovoima, May 2022).Delays and Licensing Challenges
The development of the Hanhikivi Nuclear Power Plant was characterized by a series of scheduling adjustments and licensing complexities that progressively extended the projected timeline for commercial operation. Initial project estimates suggested that the facility could supply 10% of Finland's energy demand by 2024. However, the path to achieving this target involved navigating a rigorous regulatory environment and managing the intricate design requirements of the Russian-designed VVER-1200 pressurised water reactor.
Revised Licensing and Construction Schedules
In 2018, the project operator, Fennovoima, announced a revised schedule that targeted the acquisition of the construction license in 2021, with commercial operation anticipated to begin in 2028. This timeline reflected the complexities associated with finalizing the design and securing regulatory approvals for the 1200 MW reactor unit located on the Hanhikivi peninsula in the municipality of Pyhäjoki. The licensing process required detailed scrutiny of the reactor technology and site-specific conditions, contributing to the extended preparation phase.
By April 2021, Fennovoima announced further adjustments to the project timeline, citing that the design and licensing material had taken longer than expected. Consequently, the start of construction was pushed to 2023, and the date for commercial operation was delayed to 2029. This shift highlighted the challenges inherent in coordinating the extensive documentation and technical reviews necessary for a new nuclear build in Finland. The delay from the previously anticipated 2028 start date to 2029 underscored the impact of prolonged licensing efforts on the overall project schedule.
These scheduling changes occurred against the backdrop of evolving energy market conditions and geopolitical factors. The termination of the contract with Rosatom in May 2022, following the Russian invasion of Ukraine, ultimately led to the cancellation of the project, but the preceding delays had already significantly altered the initial expectations for the plant's contribution to Finland's energy mix. The timeline of delays and licensing challenges illustrates the complex interplay between technical design, regulatory approval, and external events in the development of nuclear infrastructure.
Cancellation and Legal Aftermath
The cancellation of the Hanhikivi Nuclear Power Plant was directly precipitated by the geopolitical shifts following the Russian invasion of Ukraine in 2022. In May 2022, the project operator, Fennovoima, terminated its construction contract with the Russian state-owned nuclear energy corporation Rosatom. This decision aligned with the Finnish Government’s broader strategic declaration of rapid independence from Russian energy sources, aiming to reduce national vulnerability to external supply shocks.Regulatory Blockade
Prior to the contract termination, the project faced significant regulatory hurdles. Minister Mika Lintilä refused to issue the necessary construction permit for the facility. This refusal was a critical administrative barrier, effectively stalling the project’s progression toward the planned 2023 construction start date and the 2029 commercial operation target. The political climate in Finland had shifted dramatically, with increased scrutiny on Russian involvement in critical national infrastructure, particularly for a project involving a Russian-designed VVER-1200 pressurised water reactor.Legal Dispute and Financial Claims
The termination triggered a complex legal aftermath. In December 2022, a Dispute Review Board ruled that Fennovoima’s cancellation of the contract with Rosatom was unlawful. This ruling intensified the financial stakes of the dispute. Rosatom filed a claim for 3billiontocovercostsandlostrevenues,whileFennovoimacounter−claimed2 billion. These financial figures represent the significant capital already invested and the projected value of the 1200 MW capacity that was estimated to supply 10% of Finland's energy demand. The legal battle highlights the complexities of international energy infrastructure projects when geopolitical alliances fracture, leaving substantial financial liabilities for both the operator and the technology provider.What distinguishes Hanhikivi from other cancelled nuclear projects?
The cancellation of the Hanhikivi Nuclear Power Plant is distinguished by its primary driver: acute geopolitical tension rather than the economic or social factors that have historically plagued nuclear projects. The plant, planned for the Hanhikivi peninsula in the municipality of Pyhäjoki, was designed to house a single Russian-designed VVER-1200 pressurised water reactor with a capacity of 1200 MW. While many nuclear cancellations stem from public opposition, rising construction costs, or shifting energy mixes, Hanhikivi’s fate was sealed by the Russian invasion of Ukraine. In May 2022, the operator Fennovoima terminated its contract with Rosatom to build the plant, a decision directly linked to the geopolitical fallout from the war. This marks a significant departure from projects cancelled solely for economic reasons or public opposition, highlighting the vulnerability of energy infrastructure to international relations.
Geopolitical vs. Economic Drivers
Most cancelled nuclear projects fail due to financial overruns or local resistance. For instance, the Olkiluoto 3 reactor in Finland faced significant delays and cost increases but proceeded to completion. In contrast, Hanhikivi was cancelled despite a clear timeline: construction was scheduled to begin in 2023 with commercial operation starting in 2029. The project was estimated to supply 10% of Finland's energy demand by 2024, indicating strong initial economic viability. The termination of the contract with Rosatom underscores how geopolitical events can override economic projections, a factor less prominent in other nuclear cancellations.
Legal and Contractual Disputes
The cancellation also sparked specific legal disputes over the 'unlawful' nature of the termination. Fennovoima’s decision to end the contract with Rosatom led to complex legal battles, reflecting the intricate dependencies between the Finnish operator and the Russian state-owned nuclear giant. This legal dimension adds a layer of complexity to Hanhikivi’s cancellation, distinguishing it from projects where cancellation was a unilateral decision by the operator or government. The dispute highlights the risks associated with relying on foreign technology and construction partners in times of geopolitical instability.
These factors—geopolitical tension, the specific legal dispute over contract termination, and the contrast with economically driven cancellations—make Hanhikivi a unique case study in the modern nuclear energy landscape. The project’s cancellation serves as a cautionary tale about the interplay between energy infrastructure and international politics.
See also
- Climate Watch: Open-Source Climate Action Monitoring Tool
- Onkalo spent nuclear fuel repository
- Seitevare Powerplant: Engineering and Operations
- Vatajankoski Power Plant
- Onkalo spent nuclear fuel repository
