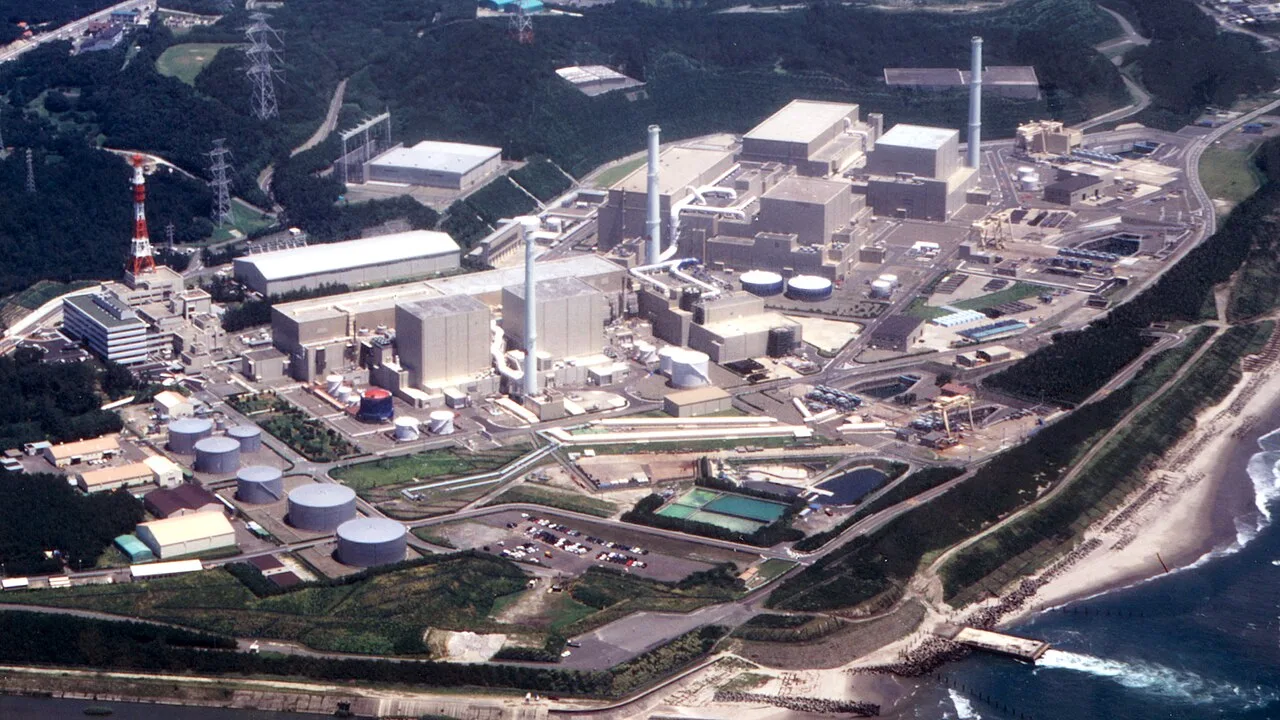

Overview

The Hamaoka Nuclear Power Plant is a major nuclear energy facility located in the city of Omaezaki, within Shizuoka Prefecture on Japan’s east coast, approximately 200 km south-west of Tokyo. The plant is managed by the Chubu Electric Power Company and occupies a single site with a net area of 1.6 km². The facility consists of five operational units. The two oldest units were permanently shut down in 2009 and are currently undergoing decommissioning processes. Units Hamaoka-3, 4, and 5 remain in a long-term shutdown status following the Fukushima accident in 2011.

Operational History and Safety Upgrades

From 2011 to 2017, the three remaining units underwent significant safety upgrades designed to enhance their resistance against extreme environmental impacts, including earthquakes and tsunamis. In 2014, Chubu Electric Power submitted an application to resume power generation for these units. However, the review process conducted by the Nuclear Regulation Authority has progressed slowly. As of 2026, the regulatory review remains ongoing, keeping the units in a state of extended suspension. A sixth unit was originally proposed in 2008, but its construction has been deferred indefinitely, reflecting the broader uncertainties in Japan’s nuclear energy landscape following the Fukushima incident.

Construction and Reactor Specifications

The Hamaoka Nuclear Power Plant, located in Omaezaki, Shizuoka Prefecture, comprises five reactor units situated on a net site area of 1.6 km². The facility is operated by the Chubu Electric Power Company and utilizes uranium as its primary fuel source. The plant's development occurred in distinct phases, incorporating evolving boiling water reactor (BWR) technologies, including the BWR-4, BWR-5, and Advanced BWR (ABWR) designs. Units 3, 4, and 5 entered long-term shutdown following the 2011 Fukushima accident and have since undergone significant safety upgrades to enhance resilience against earthquakes and tsunamis. As of 2026, the review of these units by the Nuclear Regulation Authority remains ongoing, with no resumption of power generation confirmed. A sixth unit, proposed in 2008, has been deferred indefinitely.

Reactor Specifications and Construction Timeline

The plant's five units reflect the technological progression of Japanese nuclear engineering from the early 1970s through the 1990s. The initial units employed standard BWR-4 and BWR-5 designs, while the later units incorporated the more advanced ABWR technology. Detailed specifications for each unit are provided below.

Unit Reactor Type Construction Start Commercial Operation Capacity
Hamaoka-1 BWR-4 1965 1965 600 MWe
Hamaoka-2 BWR-4 1967 1967 600 MWe
Hamaoka-3 BWR-5 1973 1973 911 MWe
Hamaoka-4 BWR-5 1974 1974 1,340 MWe
Hamaoka-5 ABWR 1987 1990 1,340 MWe

The construction of the first two units began in the mid-1960s, with commercial operation commencing shortly thereafter. These early BWR-4 units each had a capacity of 600 MWe. Subsequent units, Hamaoka-3 and Hamaoka-4, utilized BWR-5 technology, with capacities of 911 MWe and 1,340 MWe respectively. The final unit, Hamaoka-5, was an ABWR with a capacity of 1,340 MWe, beginning construction in 1987 and entering commercial operation in 1990. The total installed capacity of the five units is 3,504 MW. The plant's location on Japan's east coast, approximately 200 km south-west of Tokyo, has been a key factor in its operational history and regulatory review process.

Seismic Vulnerability and Geological Context

The Hamaoka Nuclear Power Plant is situated on Japan’s east coast in Shizuoka Prefecture, a region defined by complex tectonic activity. The site’s primary geological hazard is its proximity to the Izu–Bonin–Mariana subduction zone, where the Philippine Sea Plate slides beneath the North American Plate. This location places the facility directly in the path of potential megathrust earthquakes and subsequent tsunamis, a vulnerability that became critically apparent following the Fukushima accident in 2011.

Historical Seismic Predictions

Long before the 2011 disaster, Hamaoka was identified as a key seismic risk. In the mid-20th century, seismologist Kiyoo Mogi and the Coordinating Committee for Earthquake Prediction focused significant attention on the Tōkai earthquake, a recurring seismic event expected to strike the Shizuoka coast. These predictions designated Hamaoka as potentially the most dangerous nuclear plant in Japan due to the high probability of a direct hit from a magnitude 8.0+ event. The Coordinating Committee’s models suggested that the Tōkai earthquake could generate both intense ground shaking and a devastating tsunami, challenging the original design basis of the early reactor units.

Post-Fukushima Safety Upgrades

Following the 2011 Fukushima Daiichi accident, the seismic and tsunami vulnerabilities of Hamaoka prompted immediate action. Units Hamaoka-3, 4, and 5 entered a long-term shutdown. From 2011 to 2017, Chubu Electric Power Company implemented significant safety upgrades to enhance resistance against extreme environmental impacts. These measures included raising seawalls, installing tsunami gates, and improving backup power systems to withstand the specific threats posed by the local subduction zone. Despite these enhancements, the Nuclear Regulation Authority’s review of the plant’s safety has progressed slowly, with the review still ongoing as of 2026. The two oldest units, permanently shut down in 2009, continue their decommissioning process, while the status of the remaining three units remains contingent on regulatory approval.

The Fukushima Shutdown and Political Response

Following the Fukushima Daiichi nuclear disaster in 2011, the operational status of the Hamaoka Nuclear Power Plant underwent significant changes. The three units at Hamaoka—specifically Hamaoka-3, Hamaoka-4, and Hamaoka-5—entered a state of long-term shutdown in the immediate aftermath of the accident. This pause in generation was part of a broader national reassessment of nuclear safety in Japan. The plant, managed by the Chubu Electric Power Company, faced intense scrutiny due to its location in Shizuoka Prefecture, approximately 200 km south-west of Tokyo. The proximity to the capital region heightened concerns regarding the potential impact of a major seismic event on the energy supply and population density.

Seismic Risk and Political Intervention

The decision to keep the Hamaoka units offline was heavily influenced by specific seismic risk assessments. Estimates indicated an 87% probability of a magnitude 8.0 earthquake striking the Hamaoka site. This high probability rating prompted direct political intervention. Prime Minister Naoto Kan requested the shutdown of the Hamaoka units to mitigate the risk to the greater Tokyo area. The political response reflected the heightened sensitivity to nuclear safety following the Fukushima incident. The request underscored the tension between maintaining energy capacity and ensuring public safety in a seismically active region. The plant's location on Japan's east coast further complicated the risk profile, as it exposed the facility to both tectonic activity and potential tsunami impacts.

This application sought to restart the three shut-down units following safety upgrades. As of 2026, the review remains ongoing, indicating persistent regulatory hurdles. The slow pace of the review reflects the rigorous standards applied post-Fukushima. Legal challenges and political debates have further complicated the restart efforts. The indefinite deferral of the proposed sixth unit, originally planned in 2008, also reflects the uncertainty surrounding the plant's future. The combination of technical upgrades, regulatory scrutiny, and political pressure has kept the Hamaoka plant in a state of prolonged transition. The situation at Hamaoka serves as a case study in the complex interplay between nuclear energy policy and seismic risk management in Japan.

Post-Fukushima Safety Upgrades

Following the Fukushima Daiichi nuclear accident in 2011, Hamaoka Nuclear Power Plant entered a period of long-term shutdown to implement comprehensive safety upgrades. Between 2011 and 2017, the facility underwent significant modifications designed to enhance resistance against extreme environmental impacts, particularly earthquakes and tsunamis. These measures were critical for compliance with the new standards established by the Nuclear Regulation Authority, which had been reviewing the plant’s status for resumption of power generation since an application was submitted by Chubu Electric in 2014.

Structural and Coastal Defenses

A major component of the safety overhaul involved the construction of a 22-meter breakwater to protect the site from tsunami inundation. This structural enhancement was part of a broader effort to secure the plant’s net area of 1.6 km2 against coastal flooding, a key vulnerability highlighted by the Fukushima incident. The breakwater was designed to provide a physical barrier capable of withstanding extreme wave heights, thereby safeguarding critical infrastructure located near the shoreline.

Equipment Waterproofing and Redundancy

In addition to coastal defenses, the plant implemented extensive waterproofing measures for essential equipment, including generators. These upgrades ensured that power generation and cooling systems could remain operational even under prolonged flooding conditions. The focus on waterproofing reflected a shift toward hardening critical components against both seismic activity and water-based environmental stressors, aligning with the Nuclear Regulation Authority’s emphasis on multi-hazard resilience.

Regulatory Compliance and Review Process

The safety upgrades were conducted in response to the Nuclear Regulation Authority’s stringent review process, which has progressed slowly since 2014. As of 2026, the review remains ongoing, reflecting the complexity of validating the plant’s enhanced safety profile. The three units—Hamaoka-3, 4, and 5—have remained in long-term shutdown since 2011, awaiting final approval to resume power generation. Meanwhile, the two oldest units, permanently shut down in 2009, continue their decommissioning process, further shaping the plant’s operational landscape.

Operational Incidents and Data Fabrication Scandals

The operational history of the Hamaoka Nuclear Power Plant has been marked by significant mechanical failures and, more recently, administrative controversies regarding seismic safety data. The plant, managed by Chubu Electric Power Company, has experienced various operational incidents including valve ruptures, pipe leaks, and turbine failures across its five units. These mechanical issues contributed to the permanent shutdown of the two oldest units in 2009, which are currently undergoing decommissioning. The remaining three units, Hamaoka-3, 4, and 5, have remained in long-term shutdown since the aftermath of the Fukushima accident in 2011.

Seismic Data Fabrication and Regulatory Response

In 2026, a major revelation emerged concerning the integrity of the seismic risk data used to evaluate the plant's safety. It was disclosed that Chubu Electric Power had fabricated key elements of the seismic risk data, casting doubt on the accuracy of the safety assessments submitted to regulators. This scandal led to the immediate suspension of the ongoing safety evaluations by the Nuclear Regulation Authority. The authority had been reviewing Chubu Electric's 2014 application to resume power generation, a process that had already been progressing slowly. The fabrication of data significantly complicated the regulatory landscape, as the review process was already ongoing as of 2026.

The revelation of the fabricated seismic data has raised serious questions about the plant's resilience against extreme environmental impacts, particularly earthquakes and tsunamis. From 2011 to 2017, the units underwent significant safety upgrades to enhance their resistance to these hazards. However, the 2026 data scandal suggests that the foundational risk assessments may have been flawed, potentially undermining the efficacy of these upgrades. The suspension of the safety evaluations means that the three remaining units remain in long-term shutdown, with no clear timeline for their return to operation.

The impact of the data fabrication scandal extends beyond the immediate regulatory pause. It has affected public trust in the operator and the regulatory body's ability to ensure nuclear safety in Japan. The site covers a net area of 1.6 km2. A sixth unit was proposed in 2008, but its construction has been deferred indefinitely, partly due to the prolonged uncertainty surrounding the safety and operational status of the existing units. The 2026 scandal further cements the indefinite deferral of any expansion or restart plans for the Hamaoka Nuclear Power Plant.

Decommissioning and Restart Prospects

The two oldest units at the Hamaoka Nuclear Power Plant were permanently shut down in 2009 and are currently being decommissioned. These units represent the initial phase of the site's operational lifecycle, having been among the first to be commissioned in 1971. The decommissioning process for these two reactors is underway, with a projected completion timeline extending to 2036. This multi-year effort involves the systematic dismantling and waste management required for nuclear facilities, reflecting the long-term commitment needed for site clearance and environmental restoration. The Chubu Electric Power Company oversees these operations, managing the logistical and technical challenges associated with retiring the oldest generation of reactors at the Omaezaki site.

Restart Review for Units 3, 4, and 5

Despite these enhancements, the path to resuming power generation has been marked by regulatory delays. In 2014, Chubu Electric submitted an application to restart these units, but the review process by the Nuclear Regulation Authority has progressed slowly. As of 2026, the review is still ongoing, leaving the operational status of these three reactors in a state of prolonged uncertainty. The regulatory scrutiny reflects the heightened safety standards imposed on Japanese nuclear infrastructure in the post-Fukushima era, with the Nuclear Regulation Authority conducting thorough evaluations of the site's resilience and operational protocols.

A sixth unit was proposed in 2008, but its construction has been deferred indefinitely, further complicating the plant's expansion plans. The combination of decommissioning activities for units 1 and 2 and the stalled restart review for units 3, 4, and 5 highlights the complex operational landscape at Hamaoka. The Chubu Electric Power Company continues to manage these parallel processes, balancing the need for energy production with the rigorous safety requirements mandated by national regulators. The indefinite deferral of the sixth unit underscores the challenges faced by nuclear projects in Japan, where public perception and regulatory hurdles significantly influence development timelines.

Why it matters

The Hamaoka Nuclear Power Plant serves as a critical case study in the evolution of Japanese nuclear policy and seismic risk management. Located in Omaezaki, Shizuoka Prefecture, the facility's operational history reflects the broader challenges facing Japan's nuclear sector following the 2011 Fukushima accident. The plant, managed by Chubu Electric Power Company, features five units with a total capacity of 3504 MW, occupying a net area of 1.6 km2. Its significance lies not only in its output but in its role as a benchmark for post-Fukushima safety upgrades and regulatory scrutiny.

Seismic Risk and Safety Upgrades

Hamaoka is situated in one of Japan's most seismically active regions, making it a focal point for debates on earthquake and tsunami resilience. From 2011 to 2017, these units underwent significant safety enhancements designed to withstand extreme environmental impacts. These upgrades were critical in addressing vulnerabilities identified after the Fukushima incident, particularly regarding tsunami barriers and reactor cooling systems. The two oldest units, permanently shut down in 2009, are currently in the decommissioning phase, illustrating the lifecycle management of aging nuclear infrastructure.

Regulatory Oversight and Public Trust

The path to restarting Hamaoka has been marked by intense regulatory review and public skepticism. As of 2026, the review remains ongoing, reflecting the cautious approach adopted by Japanese regulators. This delay underscores the heightened standards for nuclear safety in Japan, where public trust has been significantly impacted by the Fukushima accident and subsequent revelations of data fabrication scandals within the nuclear industry. These scandals have intensified scrutiny on how nuclear plants report seismic data and manage operational risks.

Future Prospects

A sixth unit was proposed in 2008, but its construction has been deferred indefinitely, highlighting the uncertainty surrounding Japan's nuclear future. The status of Hamaoka remains a key indicator of the balance between energy security and public acceptance. The plant's continued shutdown, despite extensive safety upgrades, demonstrates the complex interplay between technical readiness and regulatory approval in Japan's nuclear landscape. The ongoing review process serves as a model for how nuclear facilities in seismically prone areas must adapt to maintain public confidence and operational viability.
