Overview

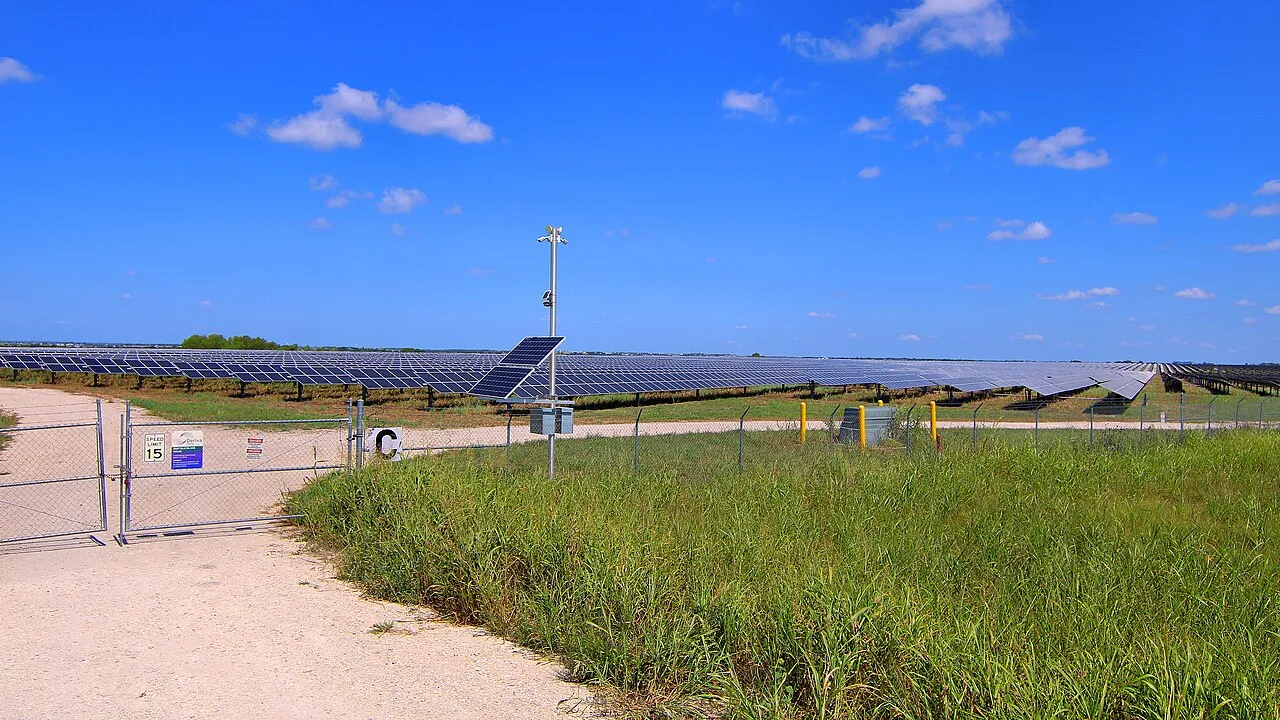

The East Blackland Solar Project, also known as the Pflugerville Solar Farm, is a solar photovoltaic (PV) power plant located near the City of Pflugerville in Travis County, Texas, United States. The facility has an installed capacity of 144 megawatts (MW) alternating current (AC) and is operated by Duke Energy. As of 2024, the project is operational, contributing to the regional energy mix with solar-generated electricity.

Development History

The development of the East Blackland Solar Project spanned more than a decade, marked by significant delays due to market conditions. The project was originally conceived as a smaller 60 MWAC facility. A ceremonial ground-breaking was announced in December 2010, with initial expectations that construction would be completed by June 2013. However, the project faced a prolonged hiatus because no buyer for the electricity was available for contract, preventing the start of construction.

Construction did not commence until July 2020, years after the initial timeline. This delay highlights the challenges in securing power purchase agreements for solar projects in the Texas market during that period. The eventual completion and commissioning in 2024 resulted in a significantly larger plant than originally planned, expanding from the initial 60 MWAC design to the final 144 MWAC capacity. This expansion reflects changes in technology, market demand, and contractual agreements over the extended development period.

Technical Specifications

The East Blackland Solar Project utilizes solar photovoltaic technology to convert sunlight directly into electricity. The plant's capacity is rated at 144 MW AC, which represents the alternating current output delivered to the grid. The facility is situated in Travis County, Texas, a region that has seen increasing investment in renewable energy infrastructure. The project's location near Pflugerville places it within the greater Austin metropolitan area, a key market for electricity consumption in Central Texas.

Duke Energy serves as the operator of the facility, managing its day-to-day operations and maintenance. The plant's operational status as of 2024 indicates that it has successfully navigated the construction and commissioning phases to begin regular power generation. The expansion from the original 60 MWAC plan to 144 MWAC demonstrates the scalability of solar PV technology and the ability to adapt project designs to meet evolving market needs.

Development History

Initial Proposal and Early Delays

The East Blackland Solar Project, also identified as the Pflugerville Solar Farm, originated as a 60 MWAC solar photovoltaic (PV) power plant proposal. In December 2010, a ceremonial ground breaking was announced for the initial 60 MWAC capacity, with completion projected for June 2013. Despite this early timeline, construction did not commence immediately. The project experienced a significant delay, with the actual start of construction postponed until July 2020. This extended hiatus was attributed to market conditions, specifically the absence of a buyer for the electricity available for contract during the intervening years.

Expansion and Recent Development

Following the commencement of construction in July 2020, the project underwent substantial development. The final installed capacity was increased from the original 60 MWAC to 144 MWAC. The facility is located near the City of Pflugerville in Travis County, Texas, United States. The East Blackland Solar Project is operated by Duke Energy and reached operational status in 2024 (per and Ground Truth). The development involved key industry participants, including RRE Mehta Power, Recurrent Energy, and Canadian Solar, reflecting the collaborative nature of large-scale solar infrastructure projects in the region. The project represents a significant addition to the solar energy infrastructure in Travis County, contributing to the regional energy mix with its 144 MWAC alternating current output.

Financing and Ownership

The East Blackland Solar Project, also known as the Pflugerville Solar Farm, represents a significant investment in Texas solar infrastructure, with a total project cost of 234million.ThefinancialstructureofthedevelopmentinvolvedsubstantialbackingfromCITGroup,whichprovided162 million in financing to support the construction and operational readiness of the facility. This capital injection was critical in advancing the project from its initial planning stages through to its final commissioning.

Ownership of the project transitioned through key phases during its development timeline. The facility was originally planned as a 60 MWAC plant, with a ceremonial ground breaking announced in December 2010. However, construction faced significant delays, with the start postponed until July 2020 due to the absence of a confirmed buyer for the electricity under contract. In 2020, Duke Energy acquired the project, securing the necessary off-take agreement to proceed with construction. This sale marked a pivotal moment for the East Blackland Solar Project, enabling the expansion from the original 60 MWAC capacity to the final 144 MWAC output.

Financial and Ownership Details

Financial/Ownership Fact Detail
Total Project Cost $234 million
Primary Financier CIT Group
Financing Amount $162 million
Original Planned Capacity 60 MWAC
Final Operational Capacity 144 MWAC
Acquisition Year 2020
Current Operator Duke Energy

The acquisition by Duke Energy in 2020 resolved the contractual uncertainties that had stalled the project for over a decade. Following the sale, construction commenced in July 2020, leading to the facility's eventual commissioning in 2024. The project's financial history highlights the importance of secured power purchase agreements in the solar energy sector, particularly for large-scale developments in the United States. The involvement of CIT Group as a major financier underscores the role of specialized energy finance institutions in bridging the gap between project initiation and operational status.

Why it matters

The East Blackland Solar Project represents a significant expansion of solar photovoltaic infrastructure in Travis County, Texas, and serves as a critical component of the regional renewable energy landscape. As a 144 MW alternating current (AC) solar farm, it stands as one of the larger utility-scale solar installations in the immediate vicinity of Pflugerville, contributing to the diversification of the power mix in Central Texas. The project’s operational status, achieved in 2024, marks the culmination of a development timeline that spanned over a decade, reflecting both the growth of solar technology and the evolving market dynamics for renewable energy procurement in the United States.

Strategic Role in Austin Energy’s Portfolio

The project is integral to Austin Energy’s renewable energy strategy, secured through a 15-year power purchase agreement (PPA). This long-term contract ensures a steady supply of solar-generated electricity for the Austin area, helping to meet growing demand and sustainability targets. The PPA structure provides revenue certainty for the operator, Duke Energy, while locking in renewable capacity for the utility, thereby stabilizing the grid with a predictable, zero-emission power source. This arrangement underscores the increasing reliance on public-private partnerships and long-term contracts to de-risk large-scale solar developments.

Development Challenges and Market Timing

The path to commissioning was marked by significant delays that highlight the importance of market timing in solar project viability. Originally conceived as a 60 MWAC plant with a ceremonial groundbreaking in December 2010, the project faced a prolonged hiatus because no buyer for the electricity was available for contract. This delay illustrates the critical role of offtake agreements in solar development; without a secured buyer, even planned infrastructure can remain dormant. The eventual expansion to 144 MW and completion in 2024 demonstrate how shifting energy markets and increased demand for solar power can revive and scale previously stalled projects, ultimately delivering substantial renewable capacity to the Texas grid.

Technical Specifications

The East Blackland Solar Project operates as a solar photovoltaic (PV) power plant with a total installed capacity of 144 megawatt (MW) alternating current (AC). Duke Energy serves as the operator of the project. The plant is currently operational and was commissioned in 2024.

The project’s development history involved significant delays before reaching its final technical configuration. The site was originally planned as a 60 MWAC plant. However, construction did not commence until July 2020. This delay occurred because no buyer for the electricity was available for contract during the earlier period. The eventual expansion from the original 60 MWAC plan to the final 144 MW AC capacity reflects the updated contractual and technical scope implemented during the later construction phase.

Technical Parameters

Parameter Value
Entity Type Solar Farm
Primary Fuel/Source Solar
Capacity 144 MW (AC)
Original Planned Capacity 60 MW (AC)
Operator Duke Energy
Location Near Pflugerville, Travis County, Texas, US
Commissioned 2024
Operational Status Operational
Construction Start July 2020

The grid connection and electricity offtake were the primary drivers for the project’s timeline. The availability of a buyer for the electricity was the specific condition that enabled the start of construction in July 2020. The plant utilizes standard solar photovoltaic technology to generate alternating current for the regional grid. The facility contributes to the energy infrastructure of Travis County and the broader Texas power market under the operation of Duke Energy. The transition from the initial 60 MWAC design to the 144 MW AC operational capacity indicates a significant scaling of the photovoltaic array and associated balance-of-system components during the development period between 2010 and 2024.

What distinguishes this project from other Texas solar farms?

The East Blackland Solar Project, also known as the Pflugerville Solar Farm, exhibits a development timeline that diverges significantly from the typical rapid deployment cycles observed in Texas solar infrastructure. Located near the City of Pflugerville in Travis County, Texas, the facility is a 144 MW alternating current (AC) solar photovoltaic (PV) power plant operated by Duke Energy, commissioned in 2024. The project’s path to operation was defined by a decade-long hiatus between initial announcement and physical construction, driven primarily by market dynamics rather than technical or regulatory hurdles.

Market-Driven Delays and Contractual Dynamics

At that time, completion was projected for June 2013. However, construction did not commence until July 2020, creating a delay of approximately ten years. The primary catalyst for this stagnation was the absence of a confirmed buyer for the electricity under contract. Without a secured off-take agreement, the financial viability of the project remained uncertain, halting progress despite the initial site identification and planning phases.

This delay highlights a critical vulnerability in utility-scale solar development: the dependency on power purchase agreements (PPAs) to lock in revenue streams before capital expenditure begins. In the Texas market, fluctuating energy prices and shifting demand forecasts can disrupt these contracts, leading to prolonged periods of dormancy for otherwise viable projects. The East Blackland Solar Project remained in this state of limbo until market conditions stabilized enough to secure the necessary contractual commitments.

Capacity Expansion and Technological Shifts

When construction finally began in July 2020, the project had evolved from its original 60 MWAC specification to a final capacity of 144 MW. This more than doubling of capacity reflects broader trends in the solar industry, including reductions in photovoltaic panel costs and improvements in energy density. The expansion allowed Duke Energy to maximize the utility of the Travis County site, enhancing the return on investment after the extended waiting period.

The shift from a 60 MW to a 144 MW installation also underscores the adaptability of solar project designs. As technology advanced between 2010 and 2020, the same land area could support a significantly higher output, making the project more competitive in the Texas grid. The eventual commissioning in 2024 marks the culmination of this extended development cycle, resulting in a substantial addition to the regional solar capacity.

Operational Timeline

The development of the East Blackland Solar Project, also known as the Pflugerville Solar Farm, was characterized by a significant period of market-driven delay before its eventual realization in Travis County, Texas. The project's origins date back to a ceremonial ground breaking announced in December 2010, at which time the facility was planned as a 60 megawatt (MW) alternating current (AC) solar photovoltaic (PV) power plant. Initial projections anticipated completion by June 2013, but the project faced a prolonged hiatus due to the absence of a confirmed electricity buyer for the power purchase contract. This commercial uncertainty prevented the commencement of construction for over a decade.

Construction activities did not begin until July 2020, marking the start of the physical development phase for the facility near the City of Pflugerville. The project was ultimately commissioned in 2024, achieving operational status with a total capacity of 144 MW, more than doubling the original 60 MWAC design. The project is operated by Duke Energy.

Timeline of Key Events

Year Event
2010 Ceremonal ground breaking announced in December for the original 60 MWAC plant design.
2013 Initially expected completion date for the project (June), which was later delayed.
2020 Construction start occurred in July, following the resolution of buyer contract issues.
2024 Project commissioned and reached operational status with a 144 MW capacity.

Frequently asked questions

What is the total capacity of the East Blackland Solar Project?

The East Blackland Solar Project has an installed capacity of 144 megawatts (MW) alternating current (AC). This figure represents the plant's current operational output as a solar photovoltaic (PV) power facility. The capacity is measured in AC, which is the standard metric for evaluating the effective power delivered to the grid by solar installations in the United States.

Where is the East Blackland Solar Project located?

It is also commonly referred to as the Pflugerville Solar Farm. This location places the plant within the central Texas region, contributing to the regional energy infrastructure of the state.

Who operates the East Blackland Solar Project?

As the operator, Duke Energy manages the day-to-day functioning and maintenance of the 144 MW solar photovoltaic plant. The facility is currently listed as operational.

When was the East Blackland Solar Project commissioned?

The East Blackland Solar Project was commissioned in 2024. This marks the year the facility officially began its operational status. The commissioning followed a prolonged development and construction phase that spanned over a decade.

Why was the construction of the project delayed?

Construction of the East Blackland Solar Project faced significant delays. Originally planned as a 60 MW AC plant, a ceremonial groundbreaking was announced in December 2010, with an initial completion target of June 2013. The project remained stalled until a contractual agreement for the electricity was secured, allowing construction to finally commence.

How did the project's capacity change from its original plan?

The East Blackland Solar Project was originally conceived as a 60 MW AC plant. However, the final operational capacity is 144 MW AC. This represents a significant increase from the initial planning stages, reflecting adjustments in project scope and energy demand during the extended development period.

Summary

The East Blackland Solar Project, also known as the Pflugerville Solar Farm, is a 144 megawatt (MW) alternating current (AC) solar photovoltaic (PV) power plant located near the City of Pflugerville in Travis County, Texas, United States. The facility is operated by Duke Energy and is currently in operational status, having been commissioned in 2024. This project represents a significant addition to the solar energy infrastructure in the state of Texas, contributing to the region's renewable energy capacity with its substantial 144 MW output. The plant utilizes solar photovoltaic technology to generate electricity, aligning with the growing trend of solar power integration into the US energy grid. The development history of the East Blackland Solar Project is characterized by a notable delay between its initial conception and final completion. Originally planned as a 60 MWAC plant, the project saw a ceremonial ground breaking announced in December 2010, with an expected completion date of June 2013. However, construction did not commence until July 2020. This significant delay was attributed to the absence of a buyer for the electricity available for contract, highlighting the market dynamics and contractual challenges that can impact renewable energy project timelines. The eventual start of construction in July 2020 marked a crucial turning point, leading to the project's expansion from the original 60 MWAC plan to the final 144 MW capacity. The commissioning of the East Blackland Solar Project in 2024 signifies the successful realization of this long-planned renewable energy asset. The plant's operational status ensures a steady contribution of solar-generated electricity to the local and regional power supply. As a Duke Energy-operated facility, the project benefits from the utility's management and integration into the broader energy network. The location near Pflugerville in Travis County places the solar farm within a key area of Texas, a state known for its diverse energy mix and significant investments in renewable resources. The 144 MW capacity underscores the project's role in enhancing the solar energy landscape in the United States, providing a tangible example of large-scale solar PV implementation.

See also

References

  1. "East Blackland Solar Project" on English Wikipedia
  2. East Blackland Solar Project - Global Energy Monitor
  3. East Blackland Solar Project - Texas Solar Energy Association
  4. East Blackland Solar Project - U.S. Energy Information Administration (EIA)
