Overview

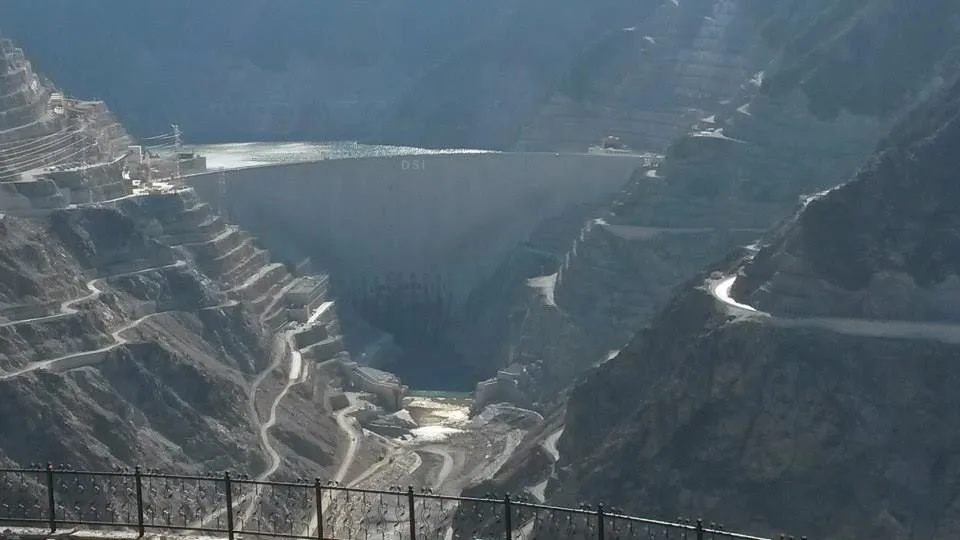

Deriner Dam is a concrete double-curved arch dam located on the Çoruh River, situated 5 km east of Artvin in Artvin Province, Turkey. As the tallest dam in Turkey, it serves primarily for hydroelectric power production and secondarily for flood control. The facility is operated by Turkey's State Hydraulic Works and was constructed by a consortium of Turkish, Russian, and Swiss companies. Construction began in 1998, with the reservoir filling starting in February 2012 and the power station completed by February 2013.

Key Specifications

Property Value
Entity Type Hydroelectric Power Plant
Location Artvin Province, Turkey
River Çoruh River
Height 249 m
Capacity 670 MW
Operator State Hydraulic Works
Commissioned 2012
Status Operational

Why it matters

Deriner Dam holds a distinct position in Turkey's energy infrastructure as the country's tallest dam, serving as the crown jewel of the extensive Çoruh Valley Project. Located on the Çoruh River, approximately 5 km (3.1 mi) east of Artvin in Artvin Province, this concrete double-curved arch structure represents a significant engineering achievement in the region's hydroelectric development. The facility's primary function is hydroelectric power production, contributing 670 MW to the national grid, while also providing crucial flood control capabilities for the surrounding areas. Its strategic importance is underscored by its role within the broader Çoruh Valley Project, a major initiative designed to harness the river's potential for energy generation and water management.

Regional Hydroelectric Significance

As a key component of the Çoruh Valley Project, Deriner Dam plays a vital role in regional energy security. The project, implemented by Turkey's State Hydraulic Works, involves a consortium of Turkish, Russian, and Swiss companies, highlighting the international collaboration required for such large-scale infrastructure. The dam's 670 MW powerhouse was completed by February 2013, following the start of reservoir filling in February 2012. This capacity adds substantial output to Turkey's hydroelectric portfolio, supporting the nation's efforts to diversify its energy mix and reduce reliance on thermal power. The operational status of the dam as of its commissioning in 2012 marks a milestone in the modernization of Turkey's hydropower sector.

Engineering and Flood Control

The construction of Deriner Dam, which began in 1998, involved complex engineering challenges due to its location and design as a concrete double-curved arch dam. Its height distinguishes it from other dams in Turkey, making it a notable landmark in the region's landscape. Beyond energy production, the dam serves an important function in flood control, mitigating the impact of seasonal variations in the Çoruh River's flow. This dual purpose enhances the resilience of local communities and infrastructure against hydrological extremes. The dam's design and implementation reflect advanced engineering practices, ensuring long-term operational efficiency and structural integrity.

The significance of Deriner Dam extends beyond its immediate technical specifications. It symbolizes Turkey's commitment to leveraging its natural resources for sustainable energy production. As the tallest dam in the country, it stands as a testament to the engineering prowess and strategic planning involved in the Çoruh Valley Project. Its contribution to both energy generation and flood management underscores its multifaceted role in the region's development. The dam's operational success since its completion in 2013 continues to support the economic and environmental objectives of the area.

History and Development

The development of the Deriner Dam began with initial surveys conducted in 1969. A master plan was subsequently developed between 1979 and 1982, followed by a feasibility study in 1987. Despite these early planning stages, the project experienced significant delays due to cost considerations and shifting priorities. A pivotal moment in the project's history was the 1994 Turkish-Russian protocol, which helped advance the initiative. In 1995, an environmental assessment was conducted to evaluate the impact of the proposed infrastructure. Construction on the dam officially began in 1998. The project was implemented by Turkey's State Hydraulic Works and constructed by a consortium of Turkish, Russian, and Swiss companies. The reservoir began to fill in February 2012, and the power station was completed by February 2013.

Construction Challenges and Progress

Construction of the Deriner Dam commenced in January 1998, initiating a complex engineering effort on the Çoruh River in Artvin Province, Turkey. The project was implemented by the State Hydraulic Works and executed by a consortium comprising Turkish, Russian, and Swiss companies. A critical early phase involved the diversion of the river to expose the foundation. Engineers constructed a 937 m long diversion tunnel to channel the water flow, allowing for extensive foundation excavation. This geological preparation was essential for the stability of the concrete double-curved arch structure. To secure the dam against hydrostatic pressure and seismic activity, 2,000 post-tensioned rock anchors were installed into the bedrock. The construction timeline experienced notable fluctuations, including a funding delay between 2006 and 2007. Despite this interruption, progress resumed with the systematic pouring of concrete for the arch body. The reservoir began to fill in February 2012, marking a significant milestone in the hydroelectric power plant's development. The power station, which houses a 670 MW powerhouse, was completed by February 2013. The Deriner Dam stands as the tallest dam in Turkey, serving dual purposes of hydroelectric power production and flood control. The structural integrity and operational readiness of the facility were confirmed upon its commissioning, establishing it as a key component of the regional energy infrastructure. The project's completion demonstrated the capability of international engineering consortia to manage large-scale hydraulic works in challenging topographical conditions.

Dam Structure and Specifications

It stands as the tallest dam in Turkey, with a height of 249 m and a crest length of 720 m. Construction began in 1998, and the reservoir started filling in February 2012. The primary purpose of the dam is hydroelectric power production, with flood control as a secondary benefit.

Dam Dimensions and Spillway Details

Parameter Value
Type Concrete double-curved arch
Height 249 m
Crest Length 720 m
Spillway Type Orifice spillway with 8 flap gates; two bank tunnels
Construction Start 1998
Reservoir Filling Start February 2012
Powerhouse Completion February 2013

The dam features an orifice spillway equipped with 8 flap gates, supplemented by two bank tunnels to manage water flow efficiently. These components are critical for both hydroelectric generation and flood control. The reservoir’s catchment area and regulating volume contribute significantly to the region’s water management and energy output. The powerhouse has a capacity of 670 MW, making it a key asset in Turkey’s hydroelectric infrastructure. The State Hydraulic Works continues to operate the facility, ensuring its role in the national energy grid remains robust.

Hydroelectric Powerhouse

The Deriner Dam project features a significant underground powerhouse located on the right bank of the Çoruh River. This facility is integral to the dam's primary function of hydroelectric power production. The powerhouse houses the generation equipment responsible for converting the potential energy of the stored water into electrical energy for the Turkish grid. The design incorporates vertical Francis turbines, a technology chosen for its efficiency in handling the specific head and flow characteristics of the Çoruh River site. These turbines drive generators within the underground cavern, optimizing space utilization and structural stability relative to the surrounding rock mass.

Capacity and Generation Output

The installed capacity of the Deriner power station is 670 MW. This output is generated by the vertical Francis turbine units operating within the underground facility. The plant is designed to produce an annual generation of 2,118 GWh, contributing significantly to the regional energy mix. This generation capacity supports the dam's role in providing a reliable baseload power source for the Artvin Province and surrounding areas. The 670 MW rating reflects the combined output of the turbine-generator sets, allowing for flexible operation depending on seasonal water availability and grid demand. The annual generation figure of 2,118 GWh indicates the plant's productivity over a typical hydrological year, accounting for variations in inflow and operational maintenance schedules.

Water Transfer and Hydraulic Infrastructure

Water from the reservoir is transferred to the powerhouse through a system of penstocks. These large-diameter conduits channel the water from the upstream intake structures down to the vertical Francis turbines. The penstocks are designed to handle the high pressure generated by the head difference between the reservoir surface and the turbine level. After passing through the turbines, the water exits the powerhouse via tail-race tunnels. These tunnels discharge the water back into the Çoruh River downstream of the dam structure. The efficiency of the penstock and tail-race tunnel systems is crucial for maximizing the net head available to the turbines, thereby optimizing the overall energy conversion process. The hydraulic infrastructure is engineered to minimize energy losses due to friction and turbulence, ensuring that the potential energy of the water is effectively converted into mechanical energy at the turbine blades.

What are the key engineering features of Deriner Dam?

The Deriner Dam represents a significant feat of civil engineering, characterized by its status as the tallest dam in Turkey. The dam serves dual primary purposes: hydroelectric power production and flood control.

Structural Design and Foundation

The dam's structural integrity relies heavily on its specific geological setting and advanced anchoring systems. The structure is built upon a granodiorite rock foundation, a choice that provides the necessary compressive strength and stability required for a double-curved arch dam of this magnitude. To further secure the massive concrete structure against hydrostatic pressure and seismic activity, engineers employed re-stressable post-tensioned rock anchors. These anchors allow for the adjustment of tension over time, compensating for potential rock deformation and ensuring long-term stability of the dam body.

Water Management and Spillways

The hydraulic design of the Deriner Dam includes sophisticated water management features. A key component is the horseshoe-shaped diversion tunnel, which plays a critical role in channeling water flow during construction and operation. This tunnel design optimizes flow efficiency and minimizes turbulence. Additionally, the dam incorporates flap gates and tunnel spillways to manage excess water volume. The flap gates allow for precise control over the release of water from the reservoir, while the tunnel spillways provide a secondary pathway for floodwaters, ensuring that the reservoir levels remain within safe operational limits even during peak flow periods.

Powerhouse Specifications

The hydroelectric powerhouse associated with the dam has an installed capacity of 670 MW. Construction on the dam began in 1998, with the reservoir starting to fill in February 2012. The power station was completed by February 2013, marking the operational readiness of the facility. The integration of the powerhouse with the dam structure allows for efficient energy generation, leveraging the significant head provided by the dam's height. The operational status of the plant is currently active, contributing to the regional energy grid.

Who were the key stakeholders in the project?

The implementation of the Deriner Dam project was led by Turkey's State Hydraulic Works (DSO), which served as the primary operator and overseeing body for the infrastructure development. The construction phase was executed by a diverse international consortium comprising Turkish, Russian, and Swiss companies, reflecting the complex engineering requirements of the site. This collaborative approach brought together specialized expertise from multiple nationalities to manage the concrete double-curved arch dam structure on the Çoruh River.

Construction Consortium

The consortium responsible for the physical construction included several prominent firms. Technostroyexport, a Russian entity, was a key participant in the building efforts, leveraging its experience in large-scale hydroelectric projects. ERG Construction, an Italian-Turkish firm, also played a significant role in the construction process. The Swiss engineering firm Stucky was involved in the project, contributing to the design and execution of the dam's structural elements. Additionally, Andritz and Alstom were part of the broader group of companies involved in the project, likely contributing to the mechanical and electrical installations necessary for the powerhouse.

Project Leadership and Naming

The dam is named after Chief Engineer İbrahim Deriner, honoring his contributions to the project. The naming convention reflects the recognition of key leadership figures in the engineering and implementation phases. The State Hydraulic Works coordinated the efforts of these various companies to ensure the project met its primary objectives of hydroelectric power production and flood control. The 670 MW powerhouse stands as the tallest dam in Turkey, showcasing the successful collaboration between the Turkish state operator and the international consortium.
